5 August 2025
The NCA is lowering the water level of Lake Burley Griffin to support construction works for the Scrivener Dam Dissipator Project.
The water level will remain up to 500mm below normal levels until construction is complete. This will be reduced as far as possible to minimise impacts to lake users.
Fluctuating lake levels may present additional hazards and we urge all lake users to consider the impacts and potential new hazards prior to setting out onto the water.
The National Capital Authority is undertaking a major project at Scrivener Dam. The project will involve strengthening work on the downstream structure of the dam – the dissipator. These works are the most significant strengthening works completed on the dam since it was first built in 1963.

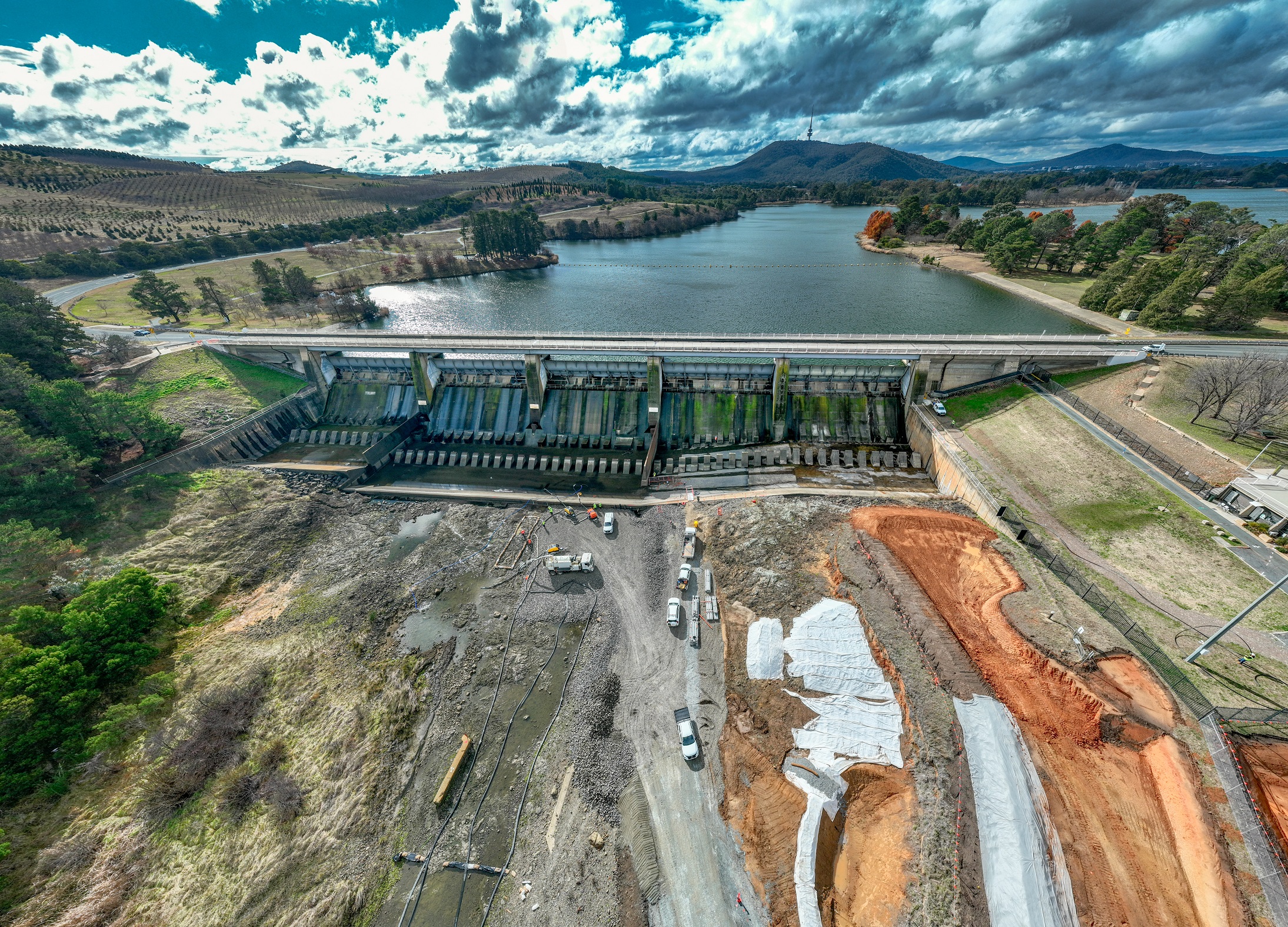

Scrivener Dam is a concrete gravity dam responsible for retaining the water which forms Lake Burley Griffin. It plays a critical role in controlling the flow of water and managing the risk of floods by controlling water levels in Lake Burley Griffin at a consistent level through five flood gates and three sluice gates, which in turn protects the residents of Canberra from flooding and downstream areas from sudden fluctuations in water flows.
Learn more about the dam on the Scrivener Dam Attractions page.
The spillway, located immediately downstream of the dam, includes a dissipator structure. The dissipator is a concrete structure comprising of a horizontal concrete slab and concrete chute blocks and vertical concrete baffle blocks. The dissipator absorbs the energy of the water flowing over the flood gates and prevents potentially damaging erosion in the river channel downstream of the dam. The chute and baffle blocks disperse water and reduce the impact of water pouring over the horizontal concrete slab structure.
Since the dam was first constructed in 1963, standards of construction and the body of knowledge regarding dam safety have improved. Based on several investigations and studies undertaken in recent years, the NCA identified several structural risks with the dissipator of the dam.
During flood conditions, there is a risk the dissipator structure could fail, which in turn could cause the dam to fail. Hence, the dissipator strengthening project is essential to ensure the ongoing safety of the dam.
Seymour Whyte was awarded the construction contract in December 2024.
Site works began in April 2025 with major works underway from June 2025 and expected to be completed in October 2027.
During construction there will be an increase in construction traffic on Lady Denman Drive. Construction traffic will enter the site on the western access road to Scrivener Dam and will cross the existing bike path adjacent to Lady Denman Drive. Traffic will be controlled during construction hours however we urge all users to take care when navigating the area.

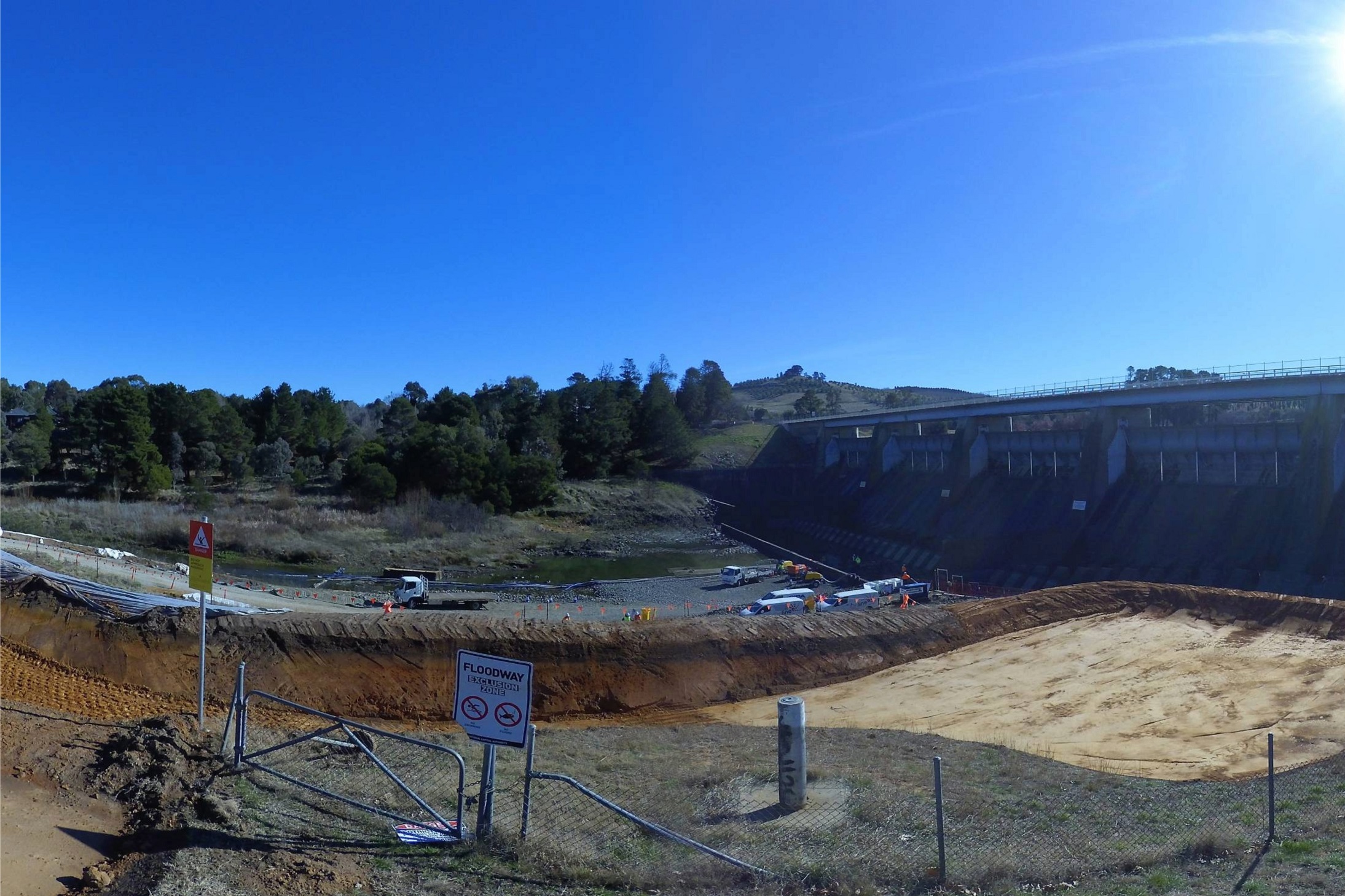

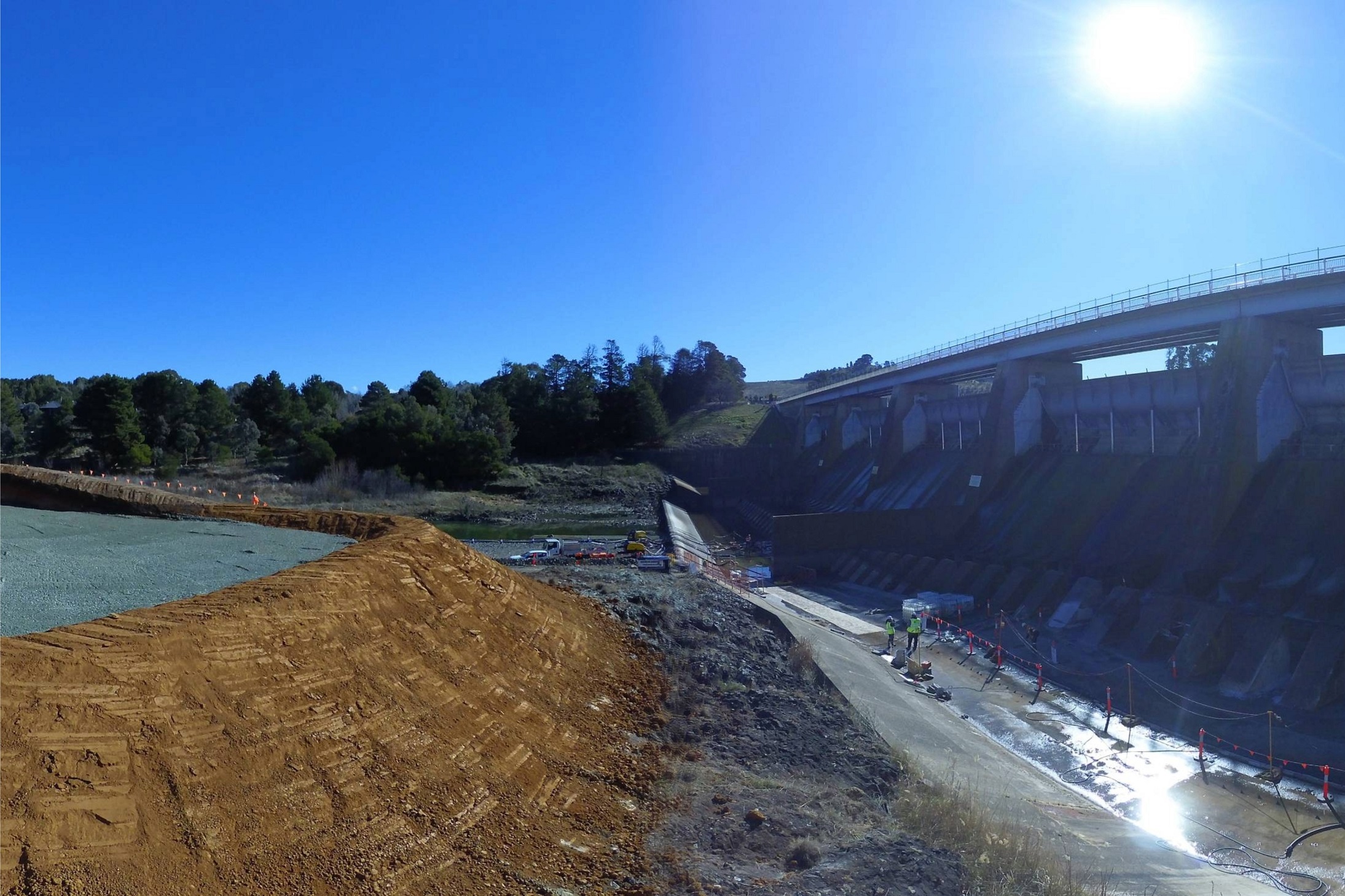

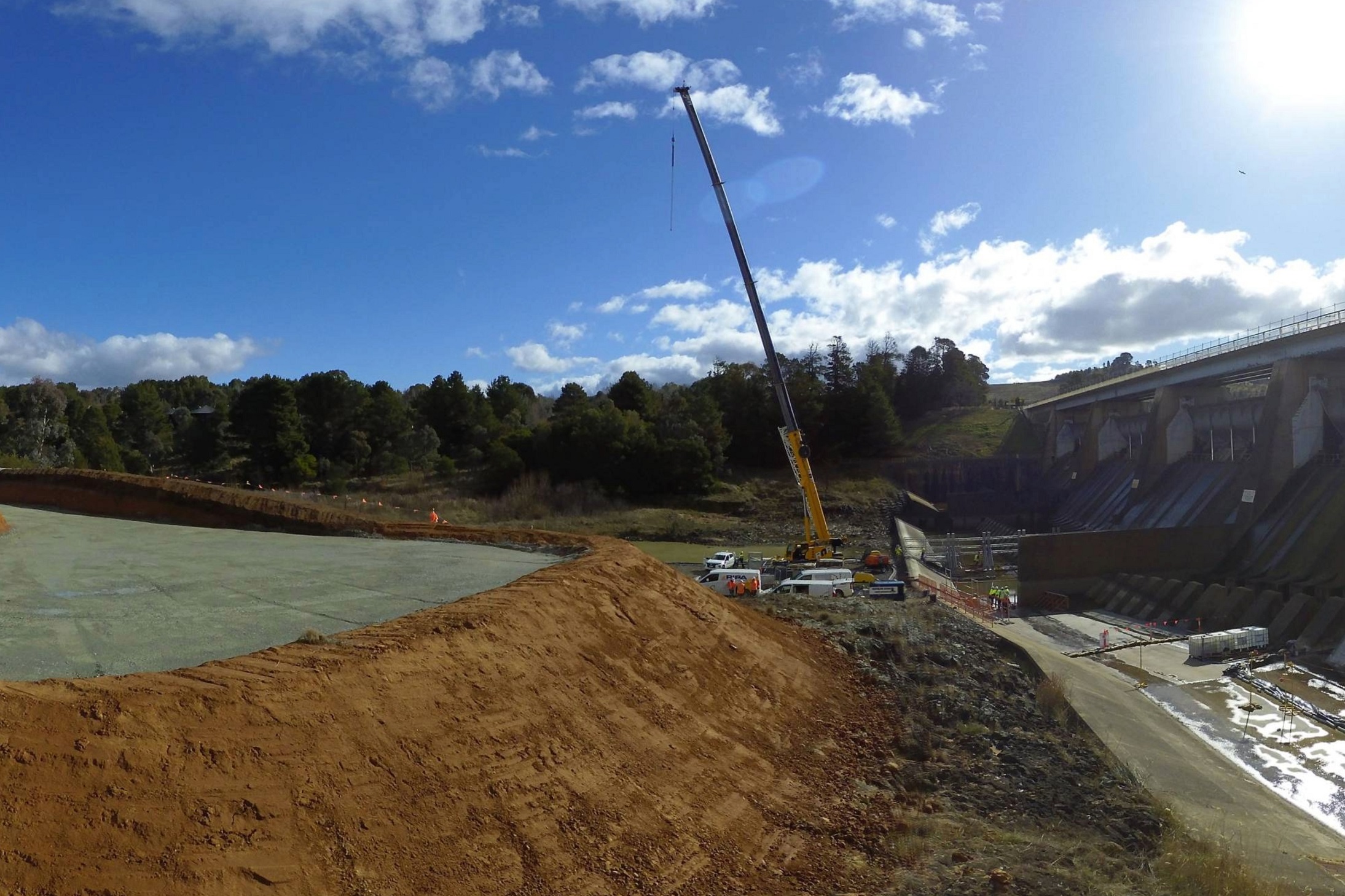

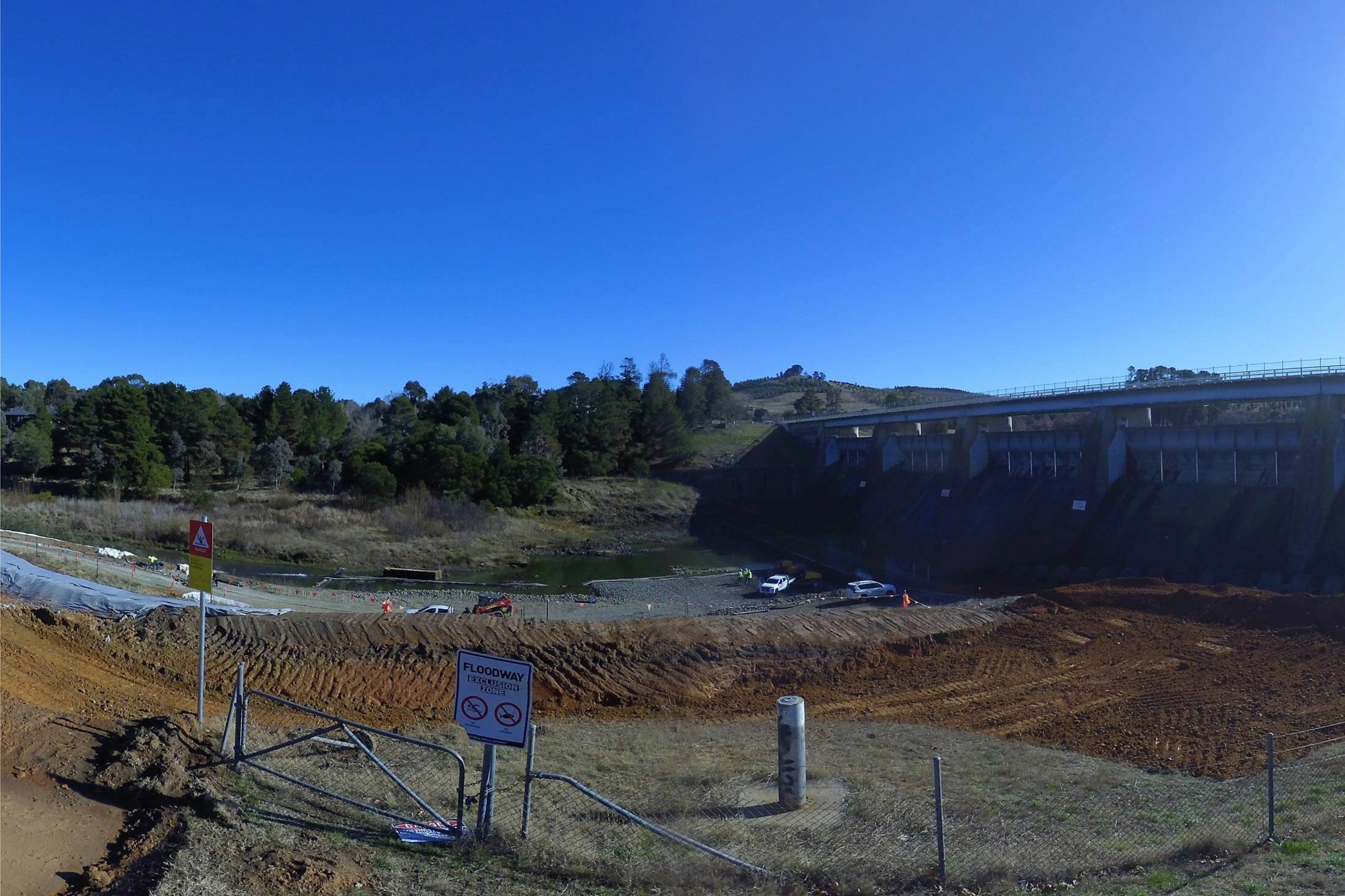

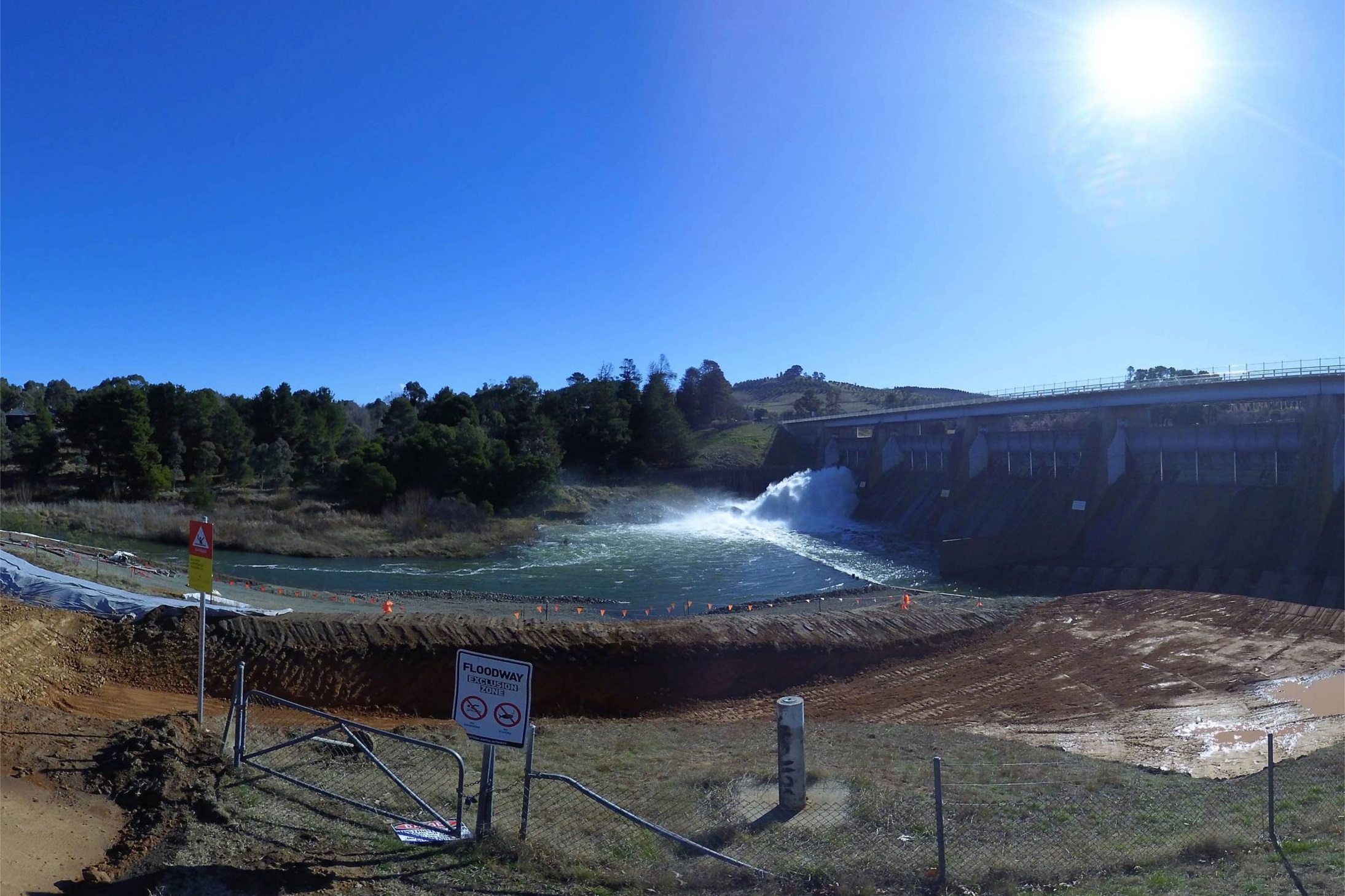

To manage risks associated with working in the spillway of the dam, it is necessary to lower the level of the lake during construction. It is planned to lower the lake by a maximum of 500mm during construction. This will be reduced as far as possible to minimise the impact to lake users. We urge all lake users to consider the impacts and potential new hazards prior to setting out onto the water.

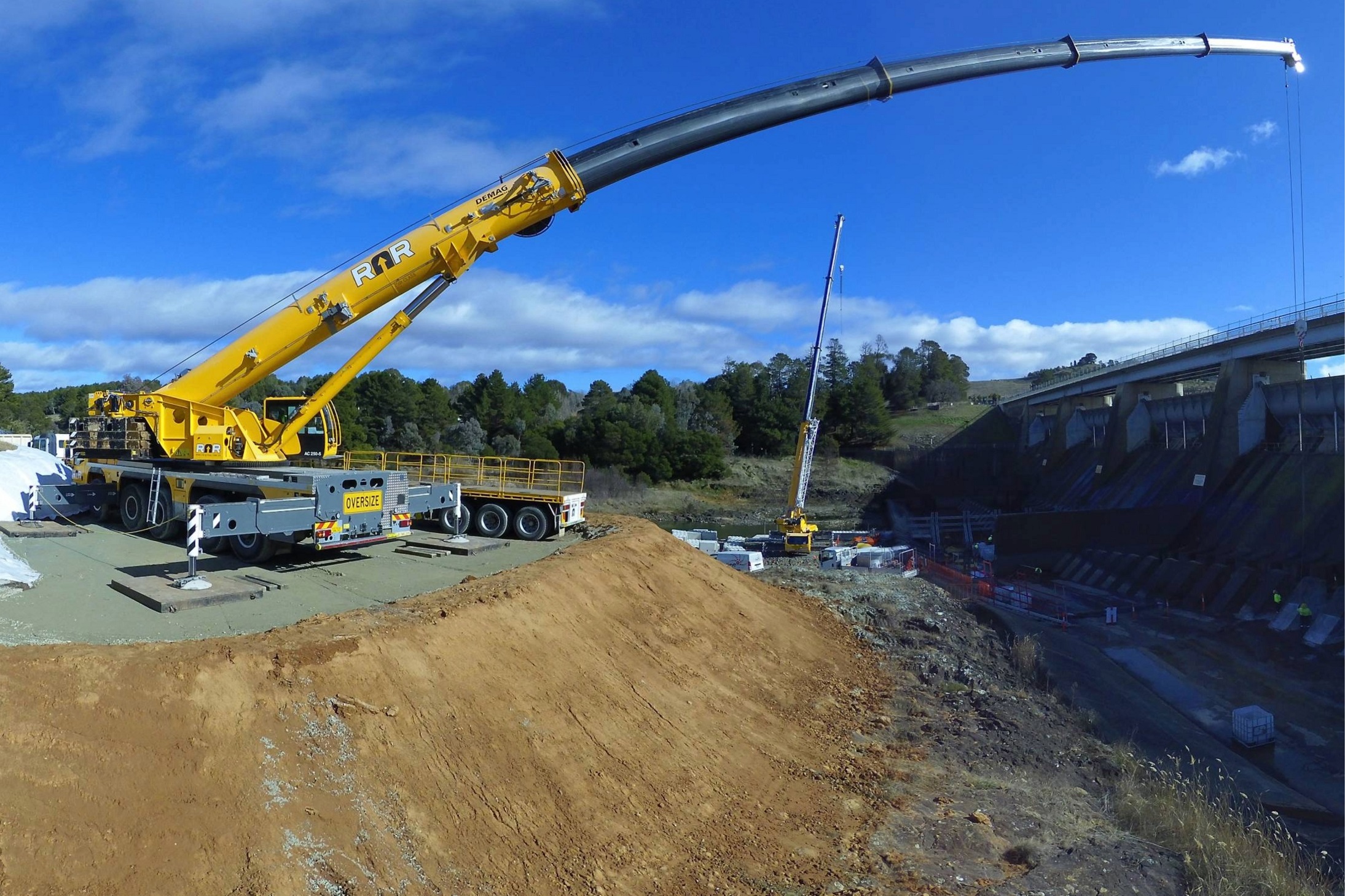

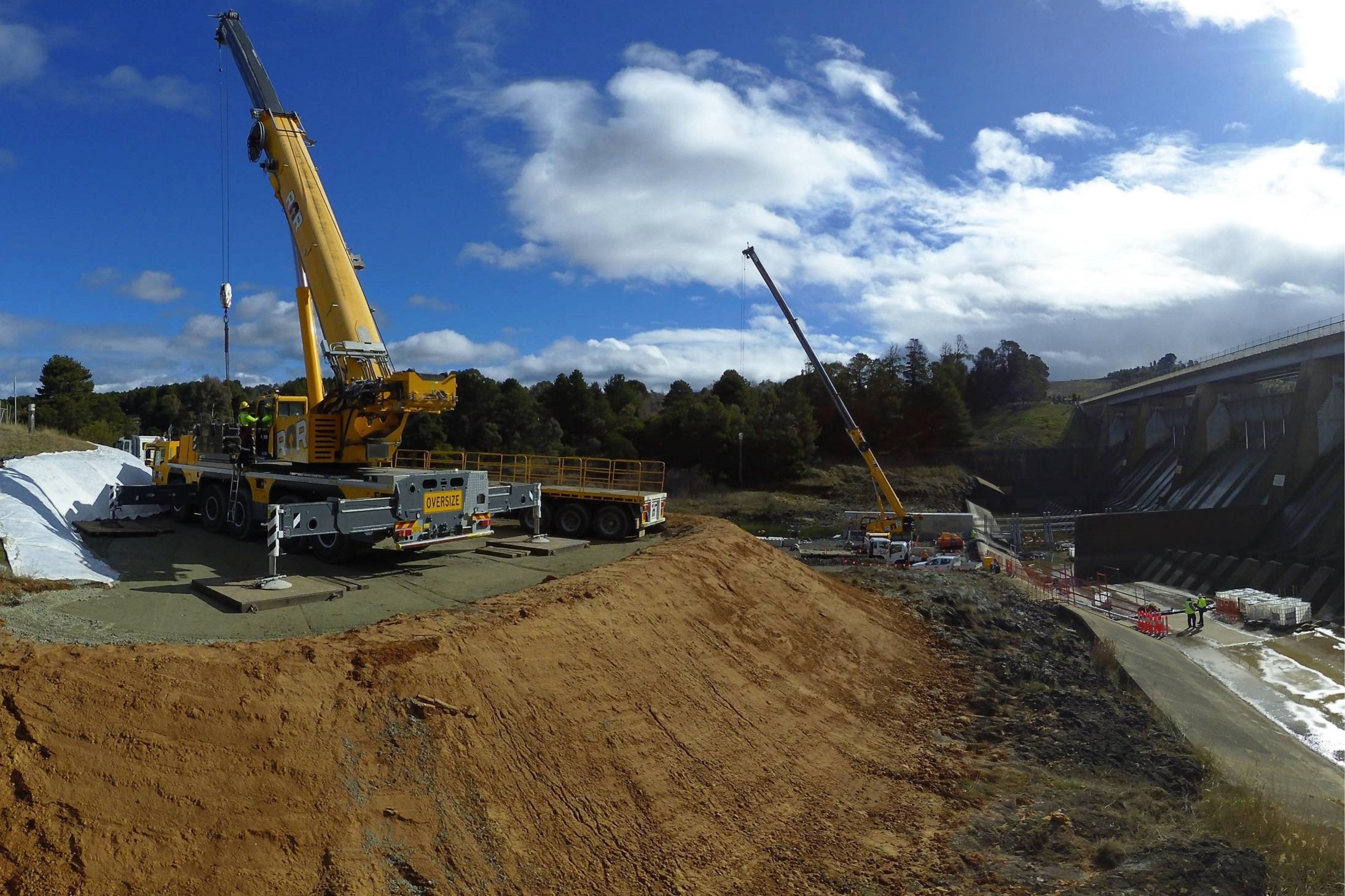

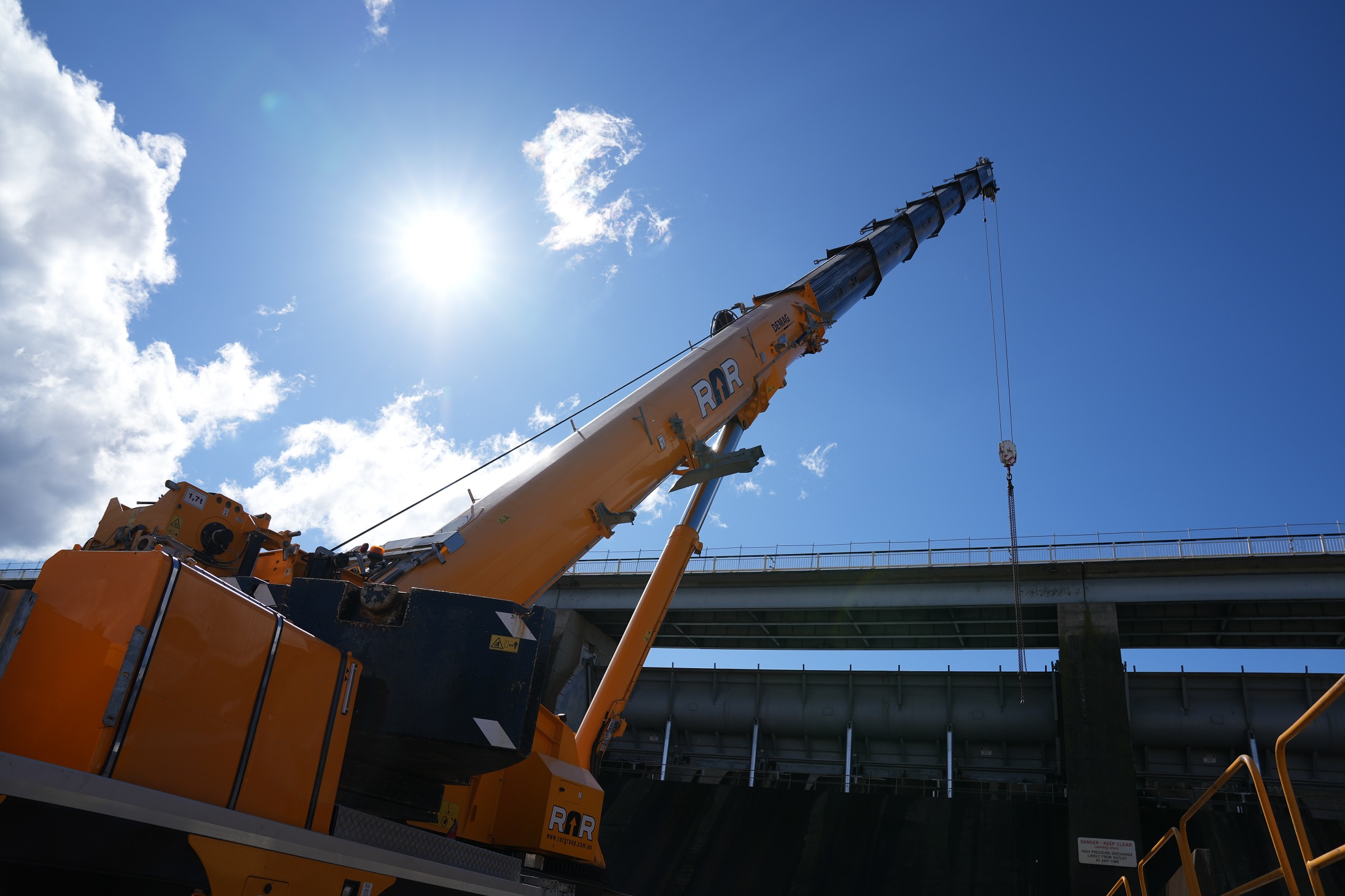

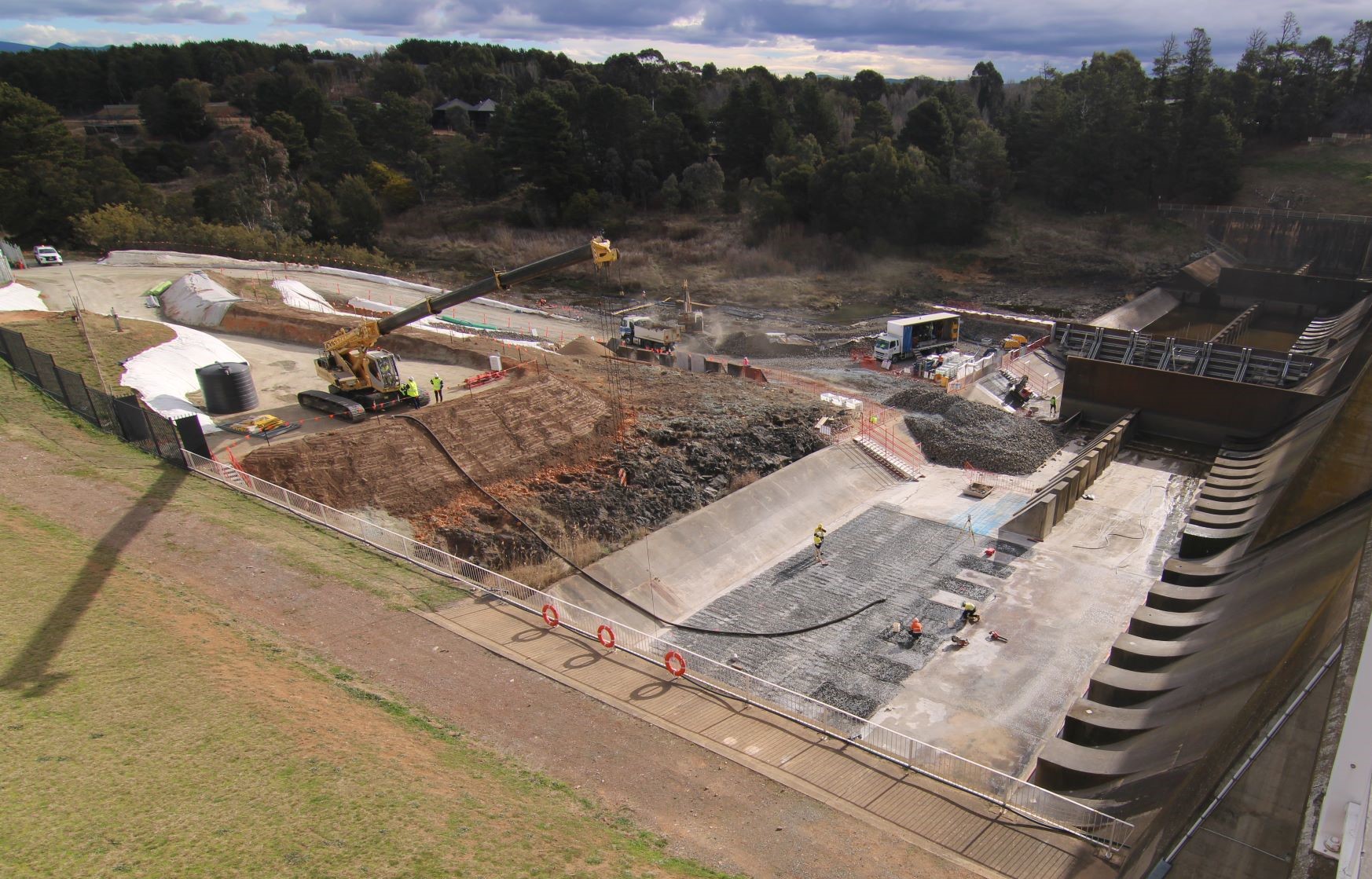

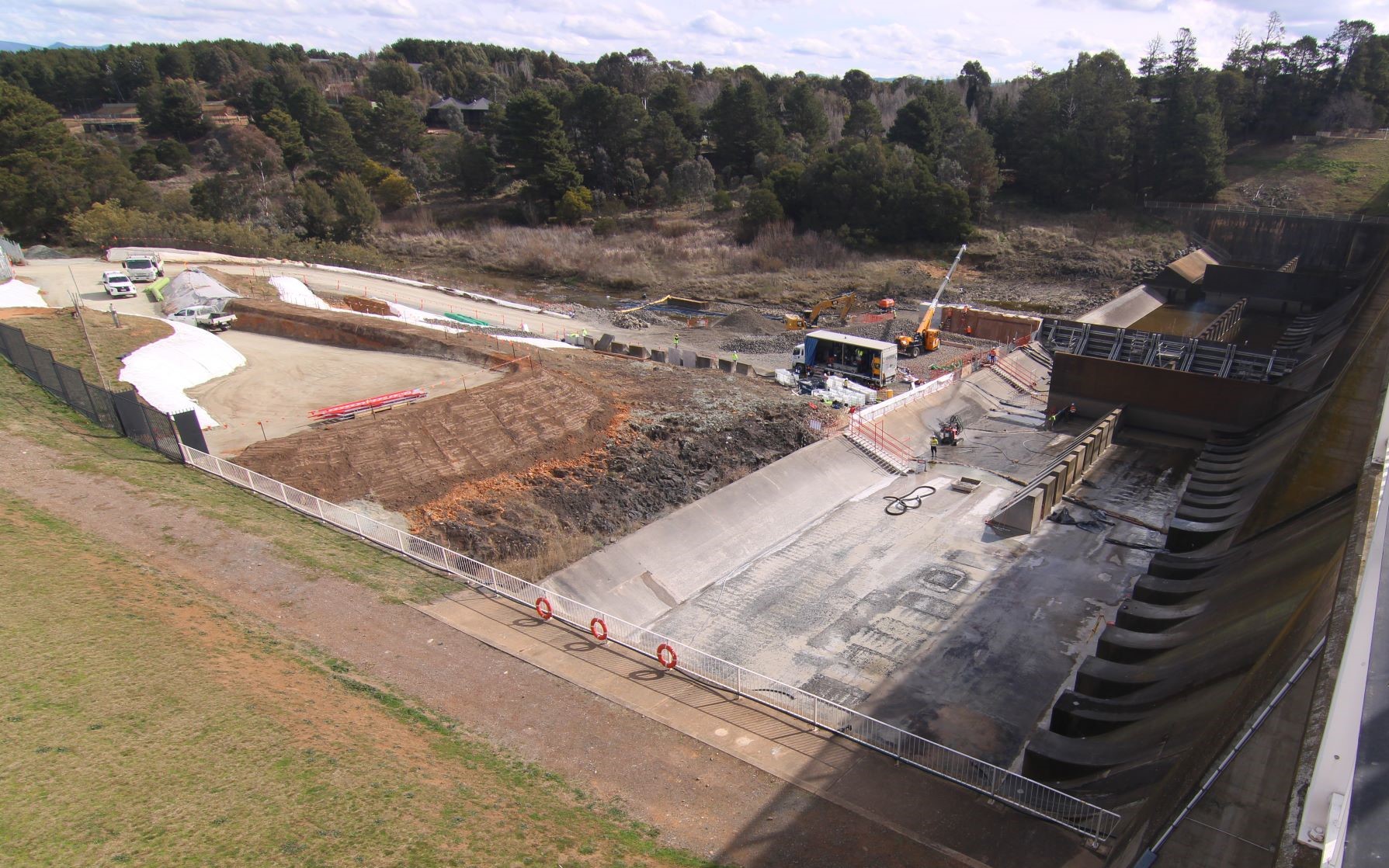

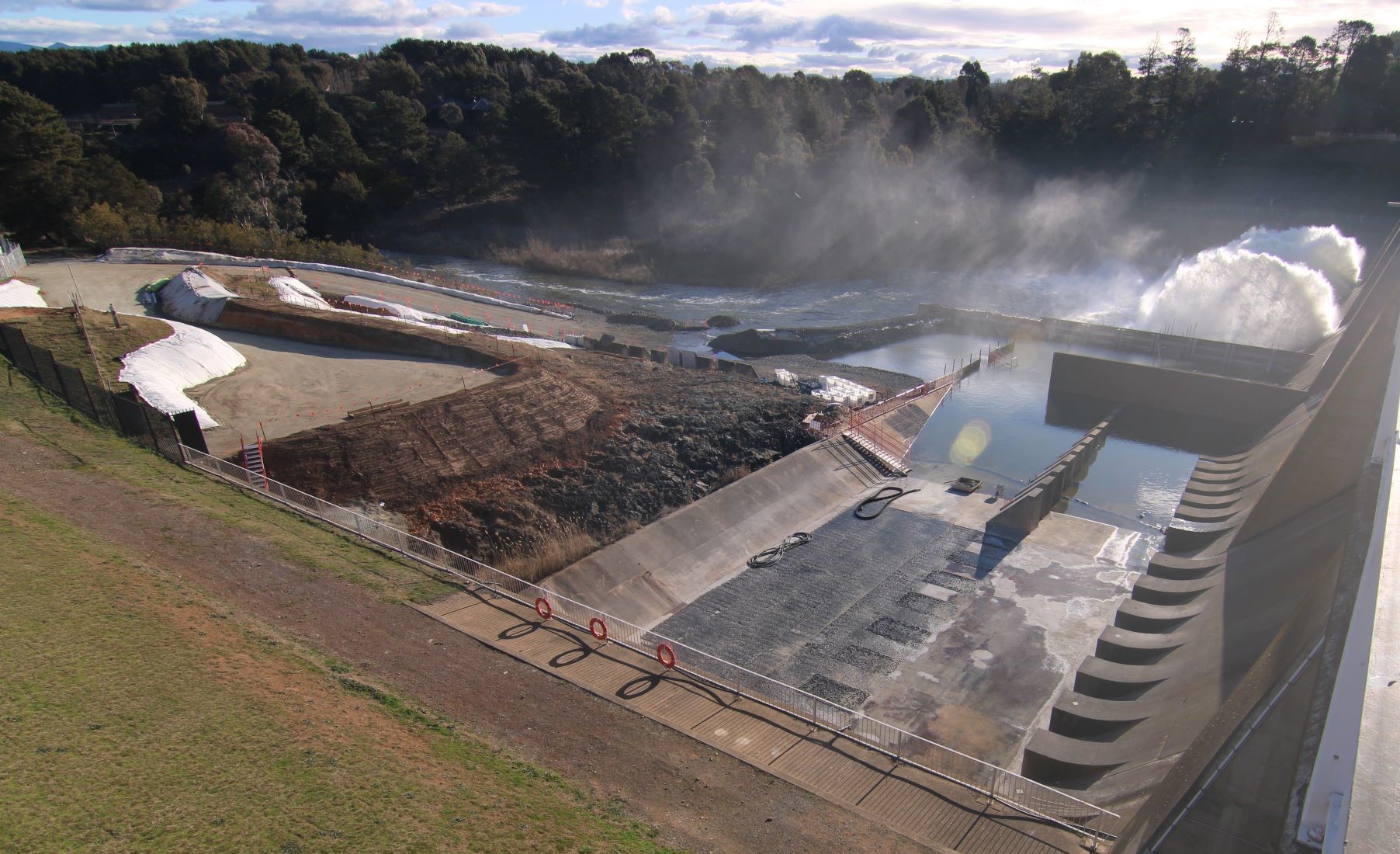

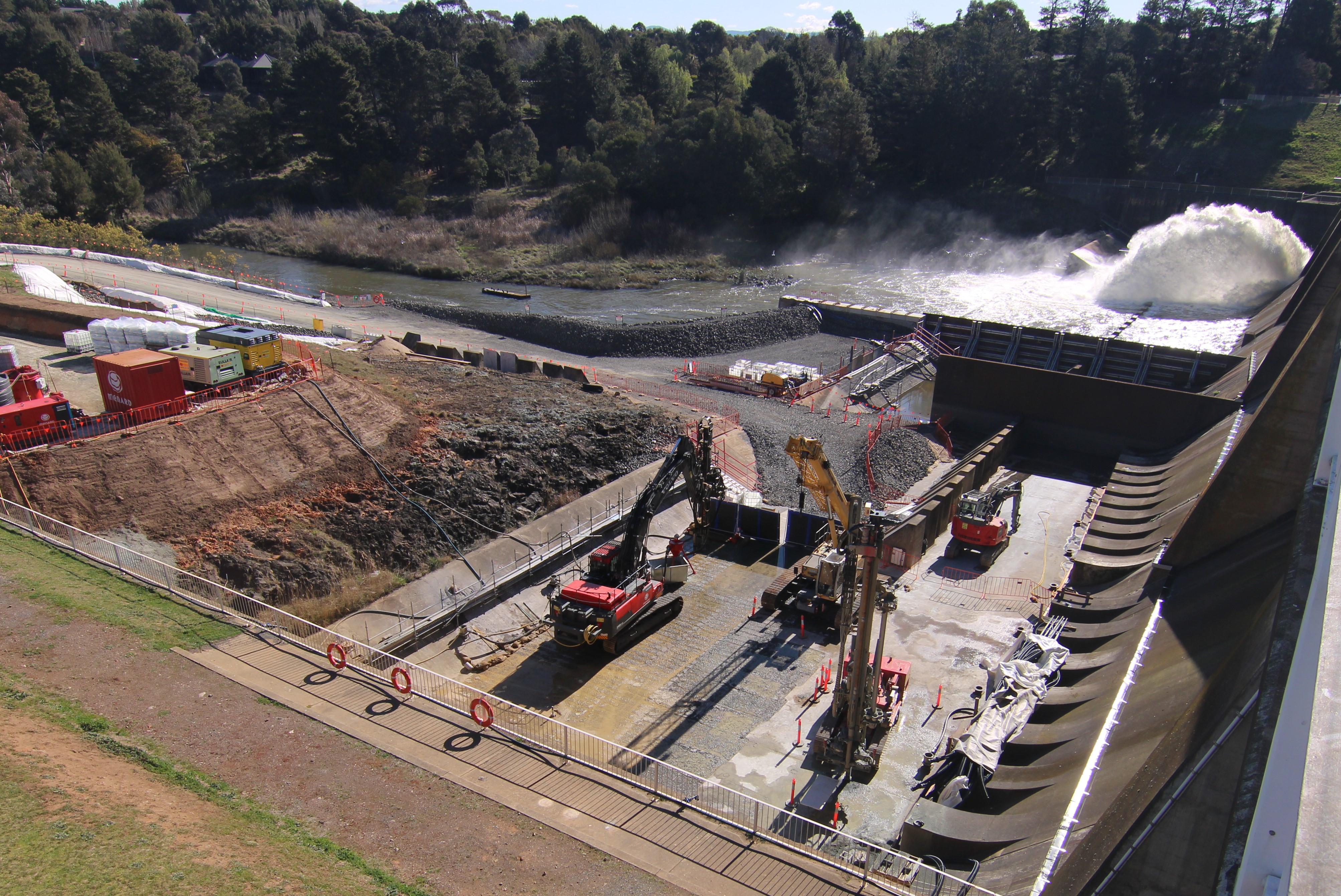

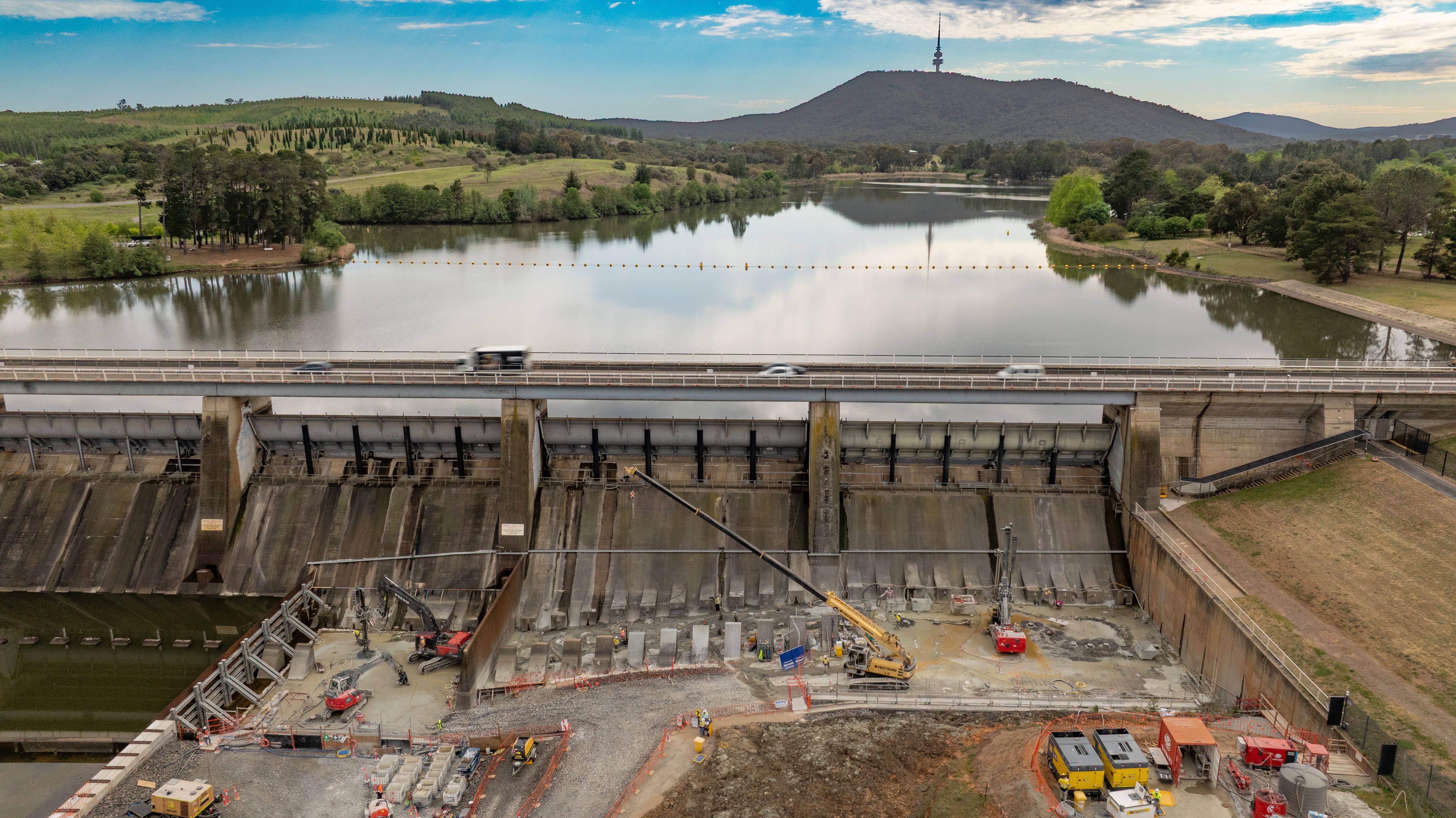

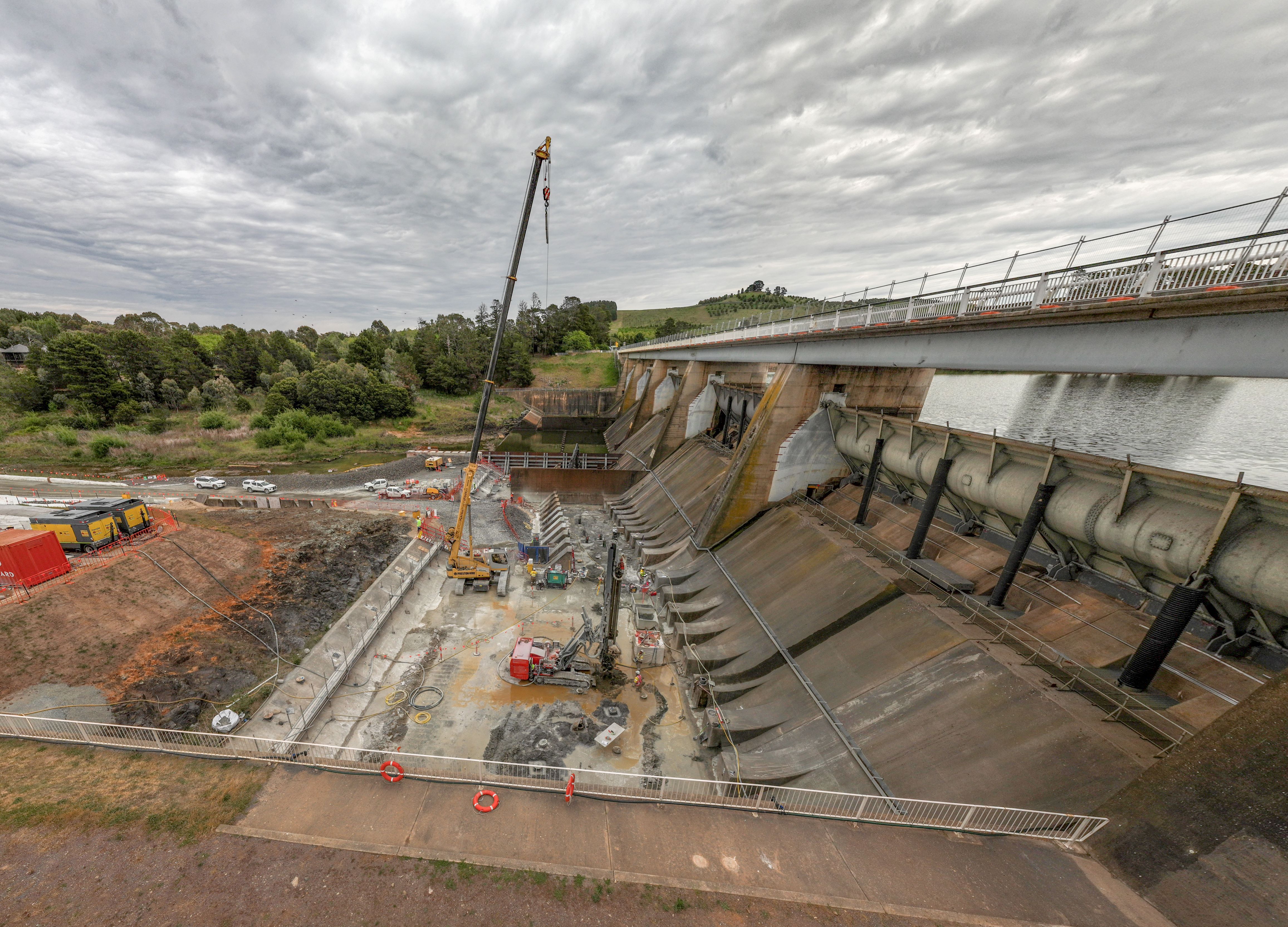

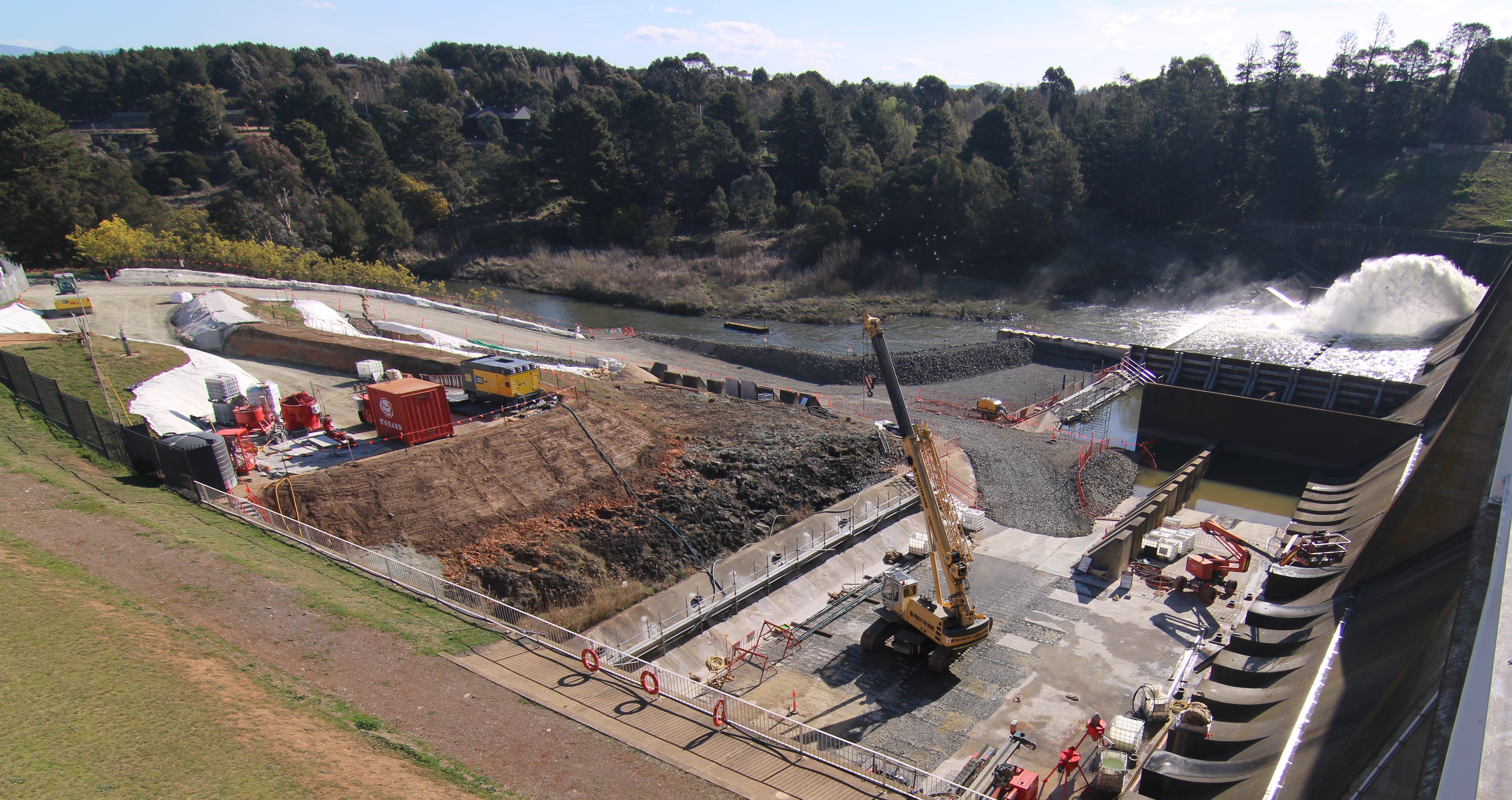

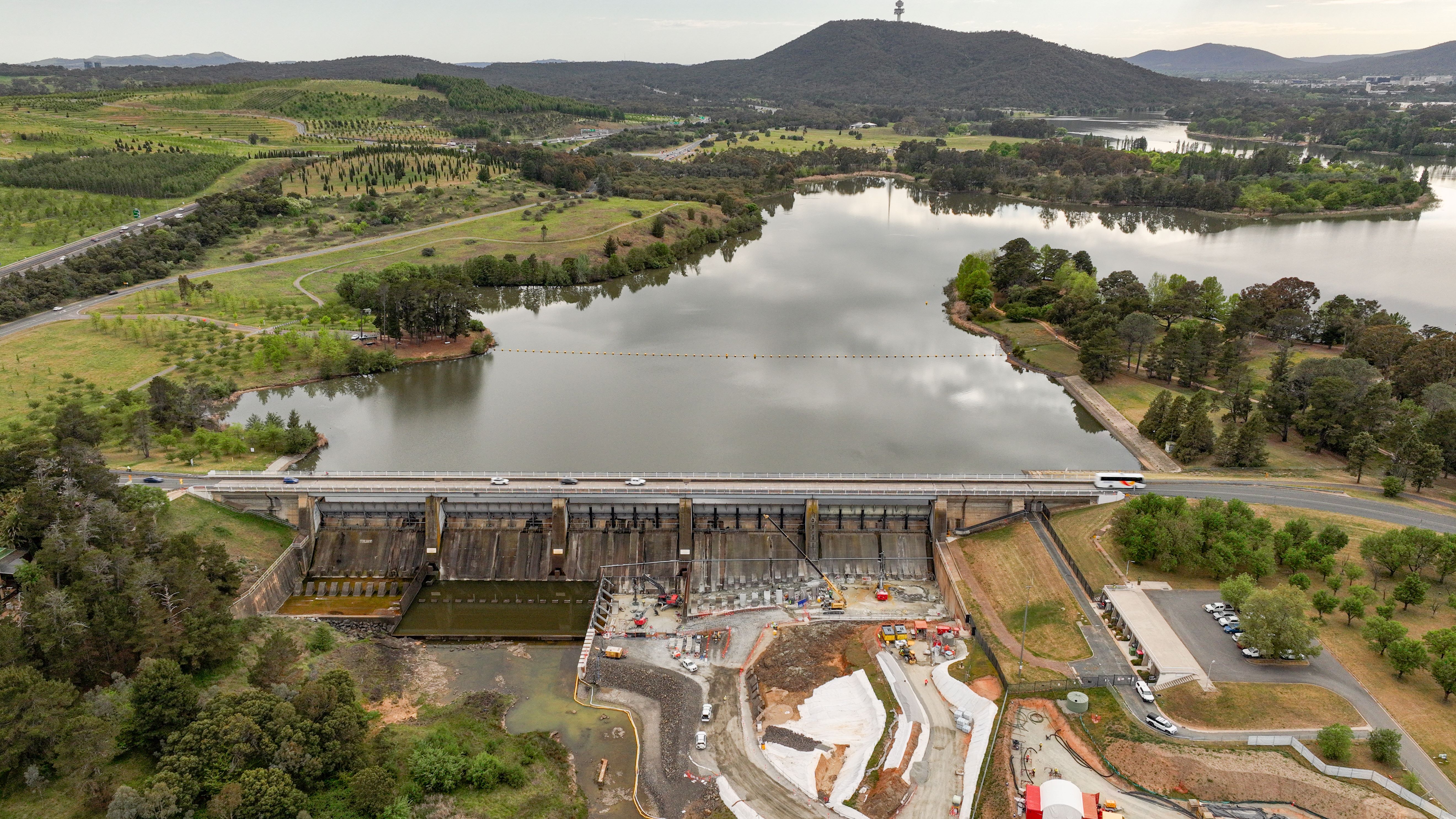

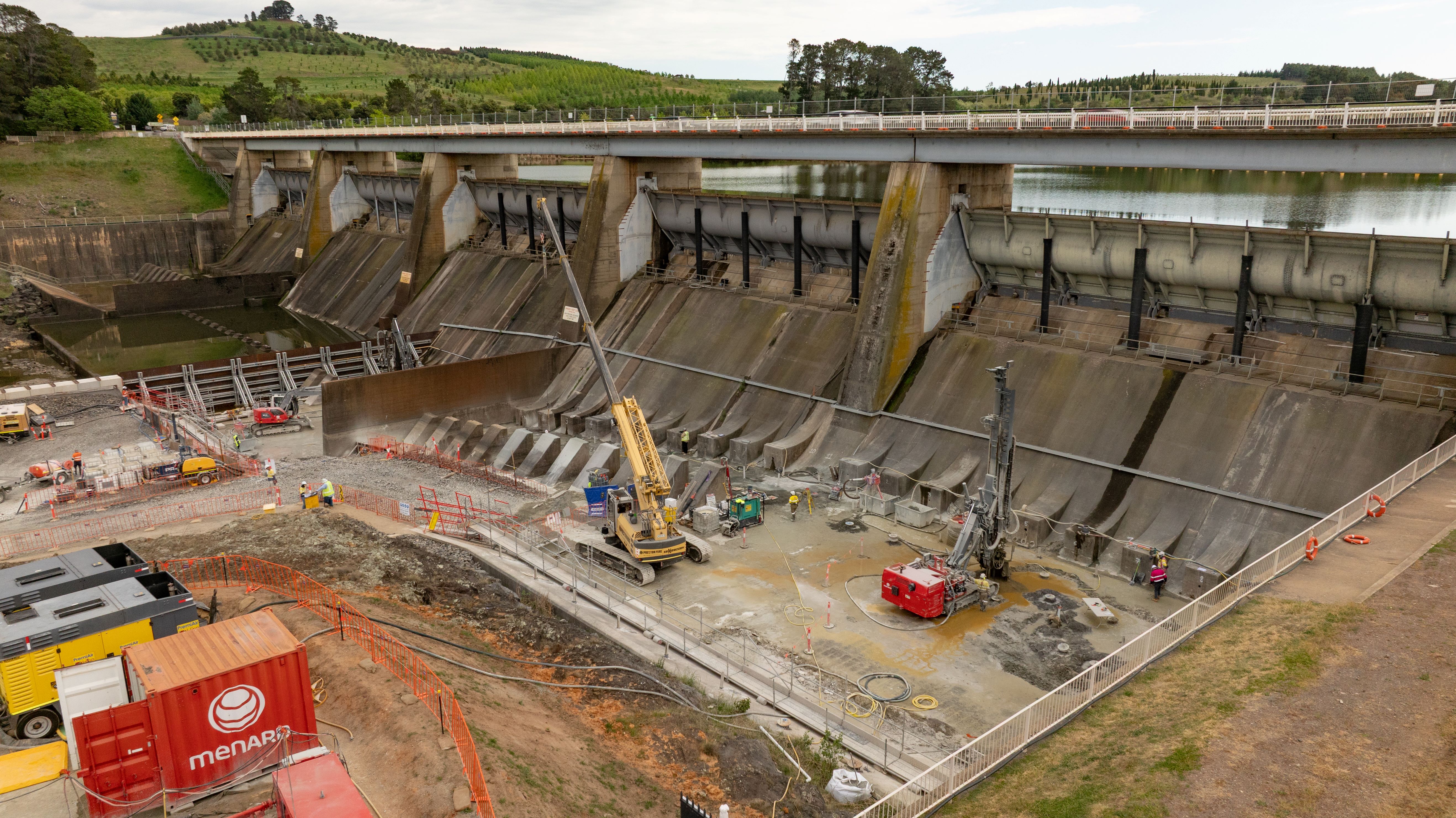

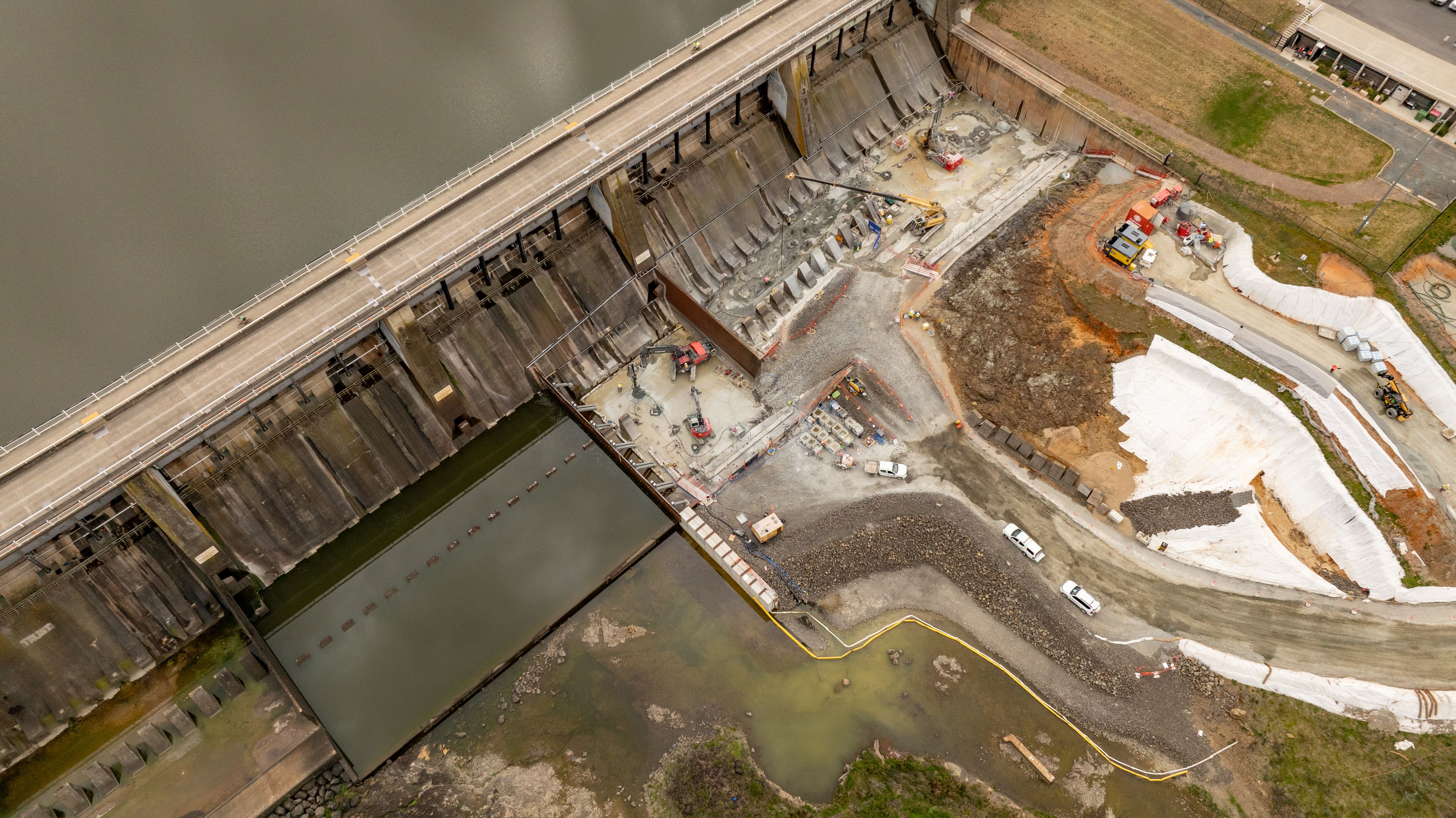

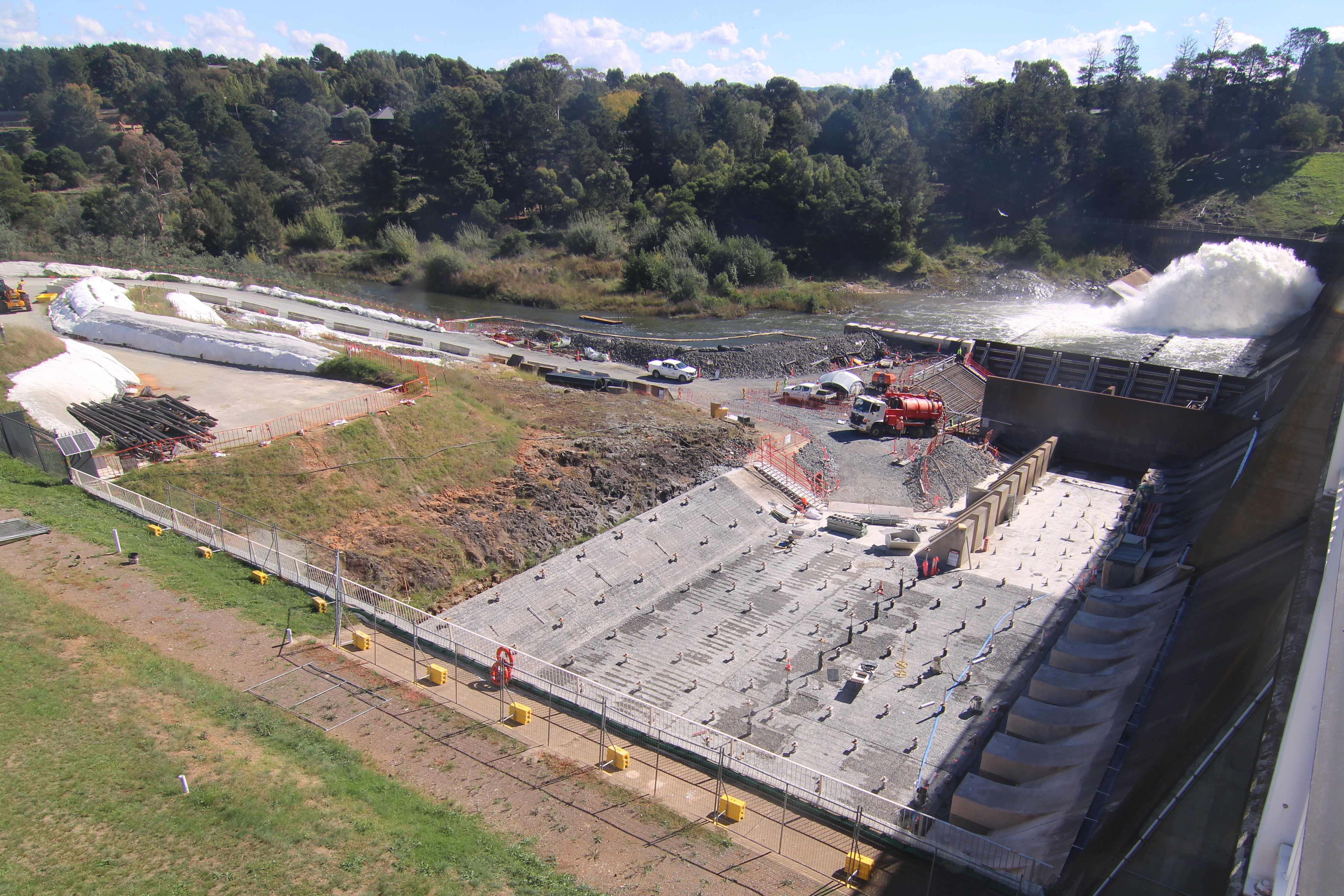

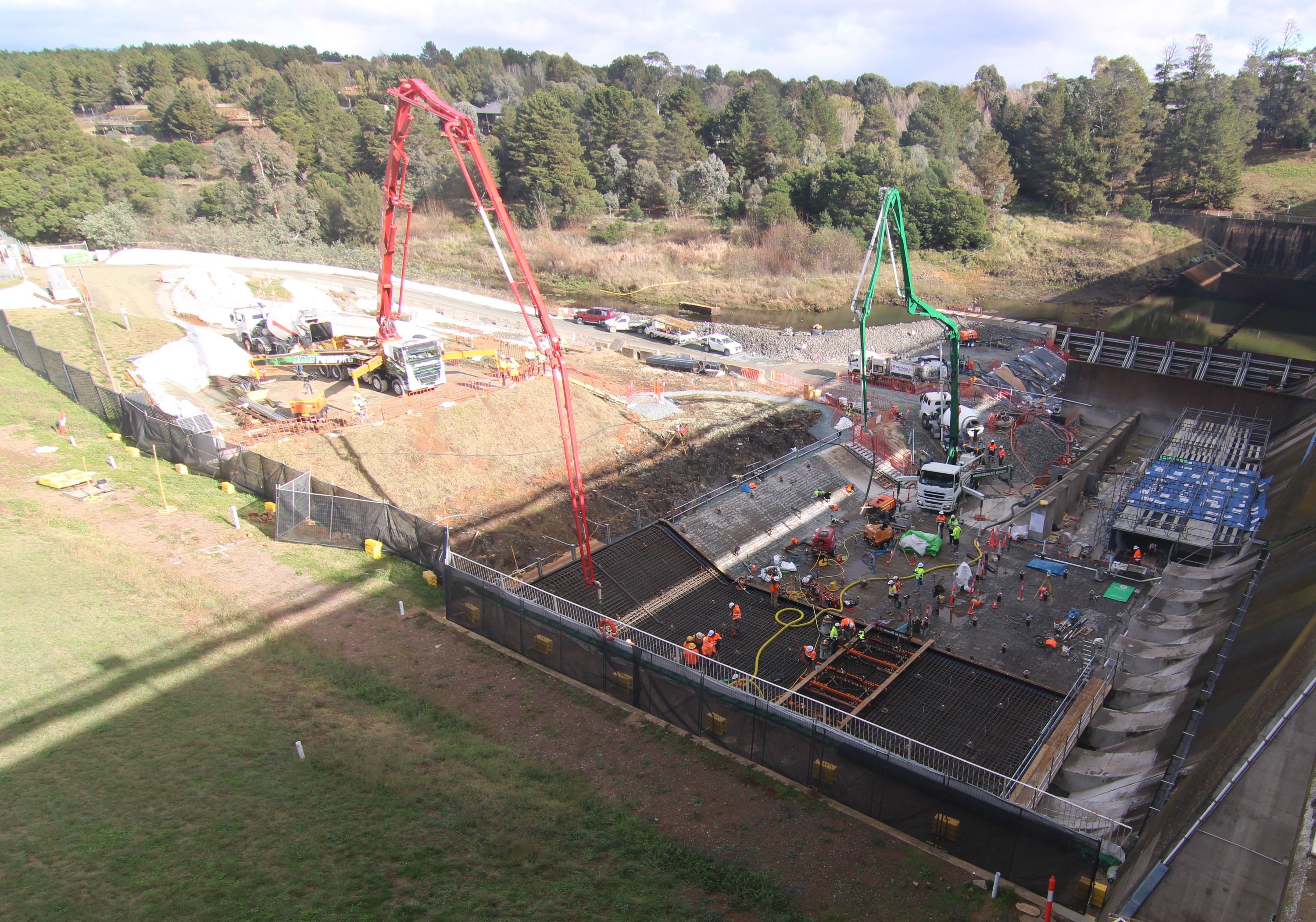

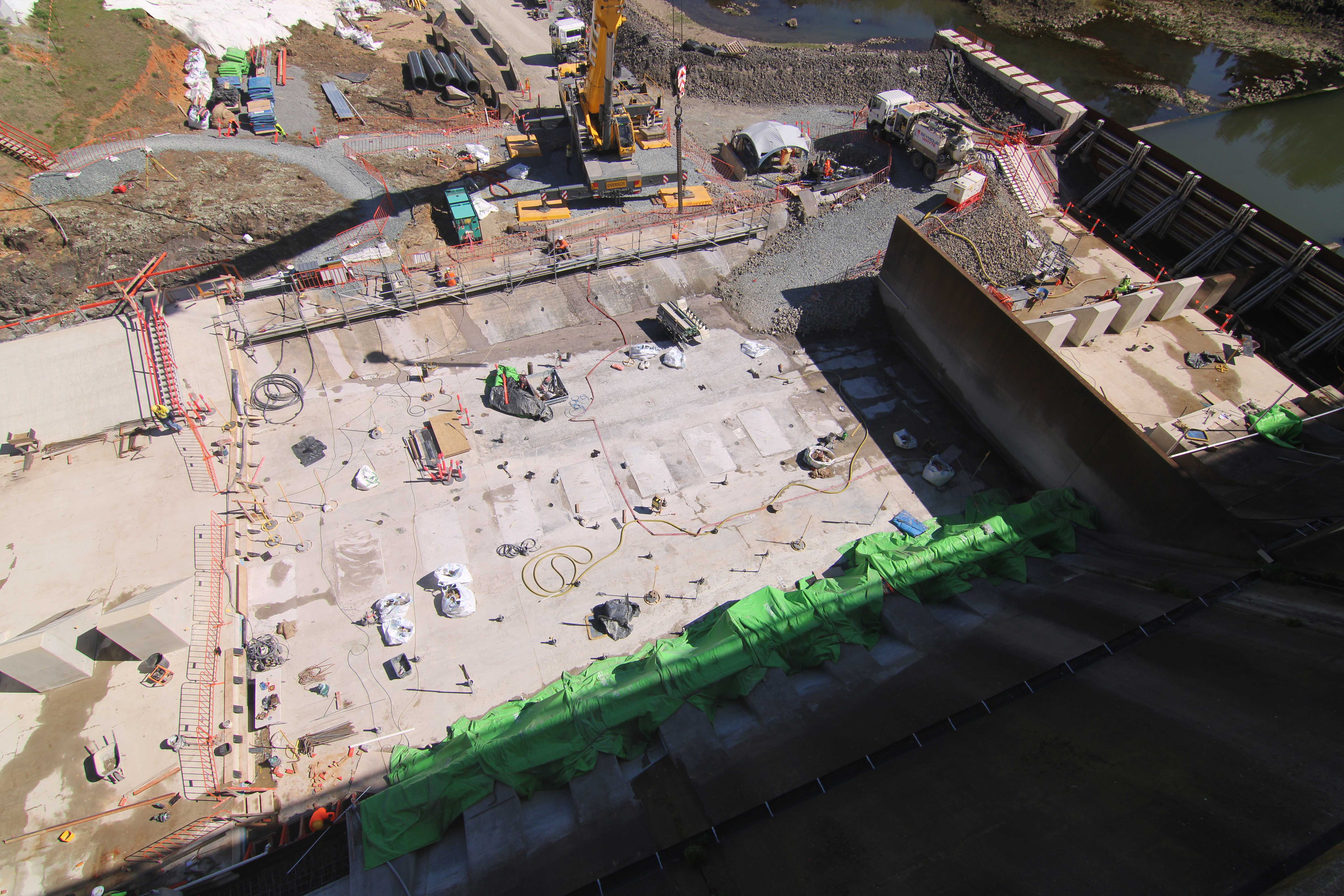

Major works are being carried out in two main stages as shown in the image below. The stages will be separated by a temporary cofferdam which will allow operation of the dam around the construction site.

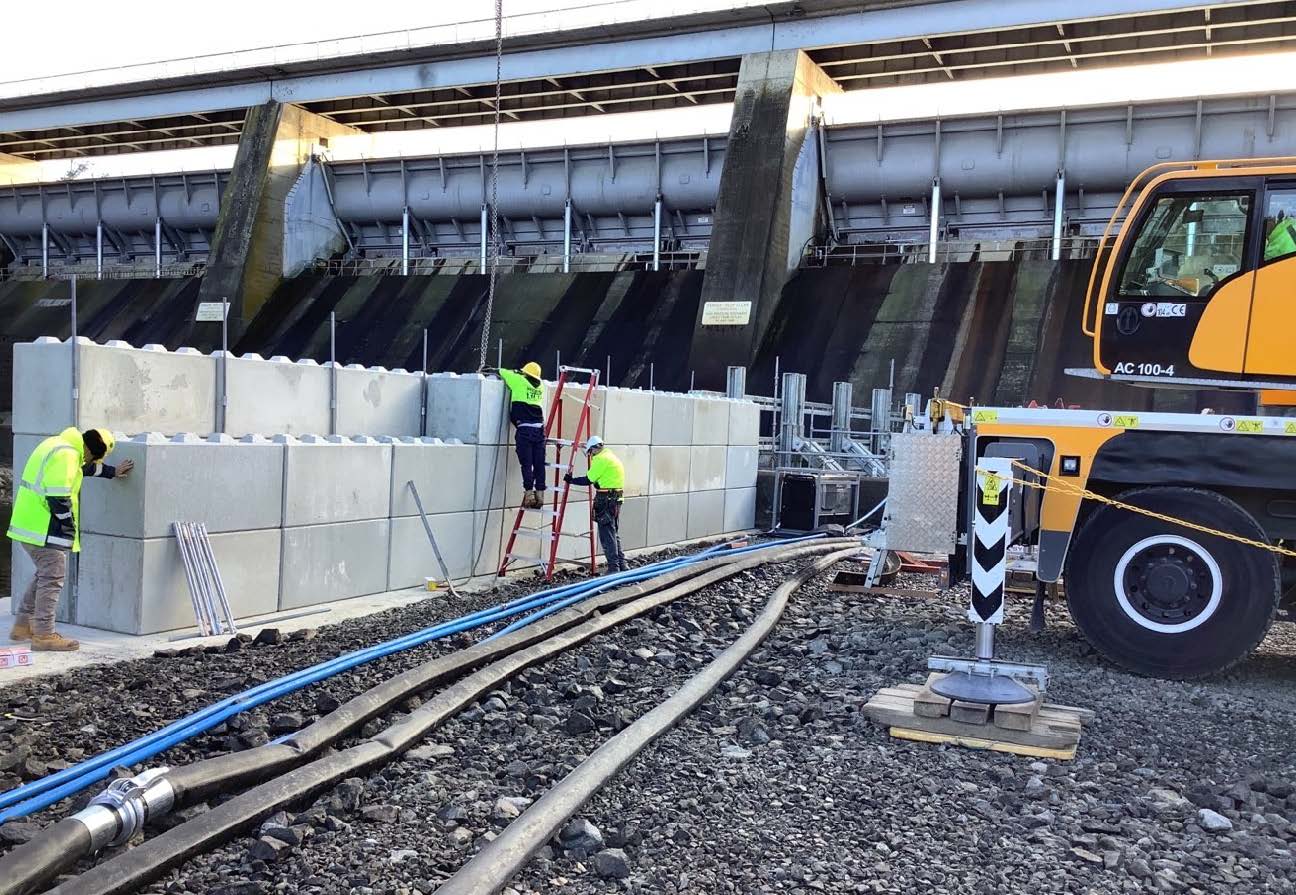

What is a cofferdam?
A temporary enclosure built within or around a body of water to create a dry area for construction or repair work.

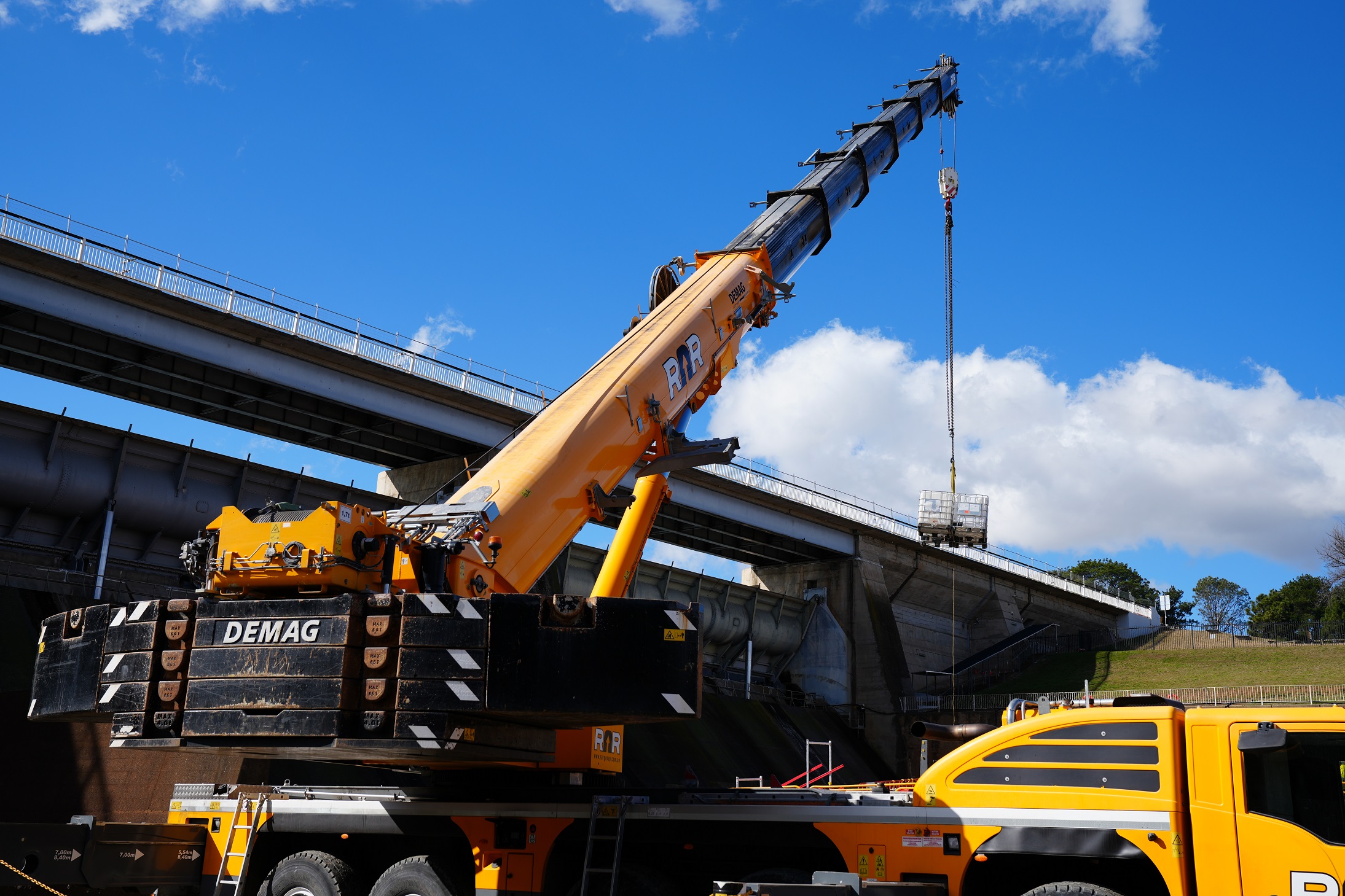

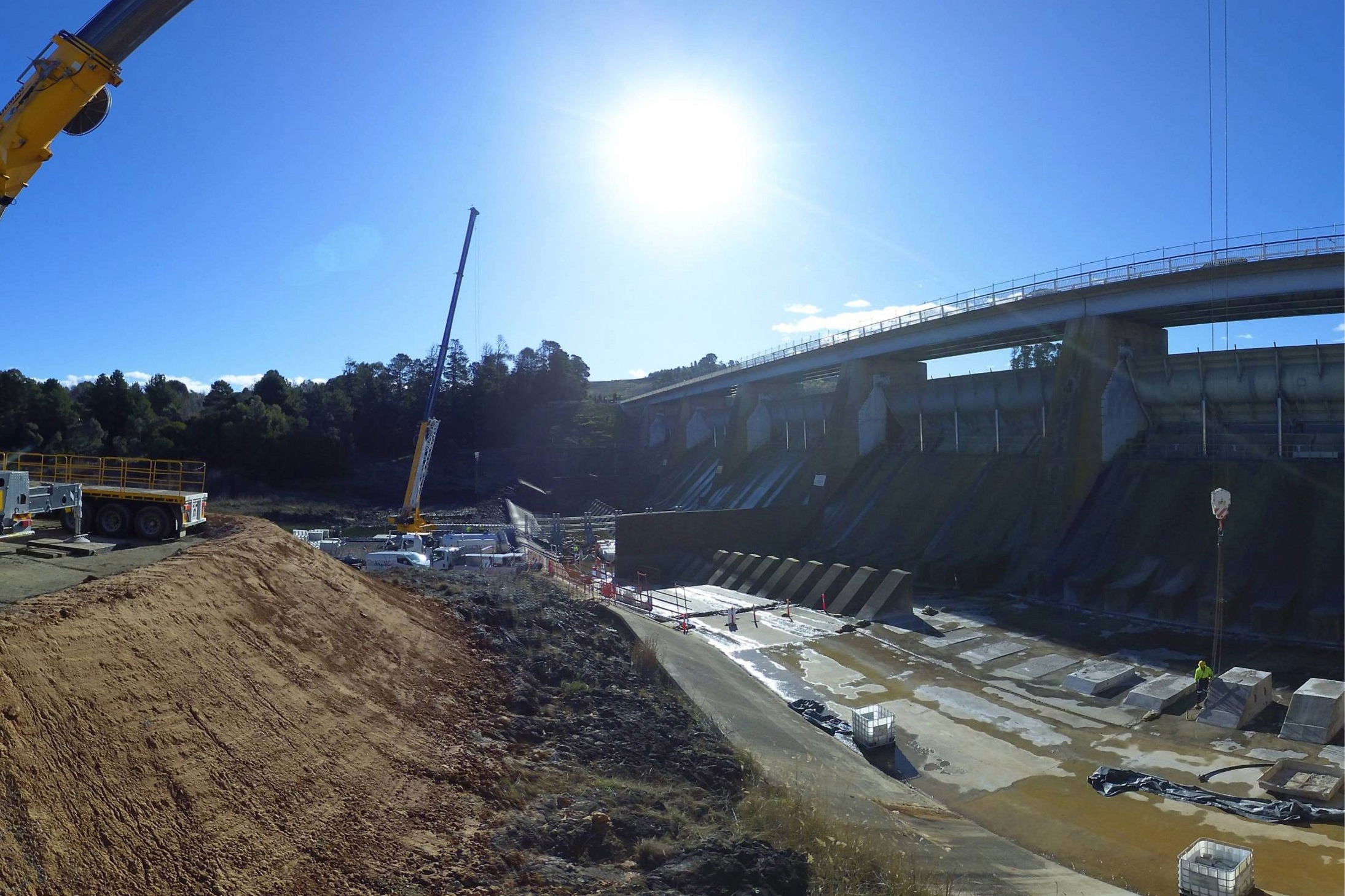

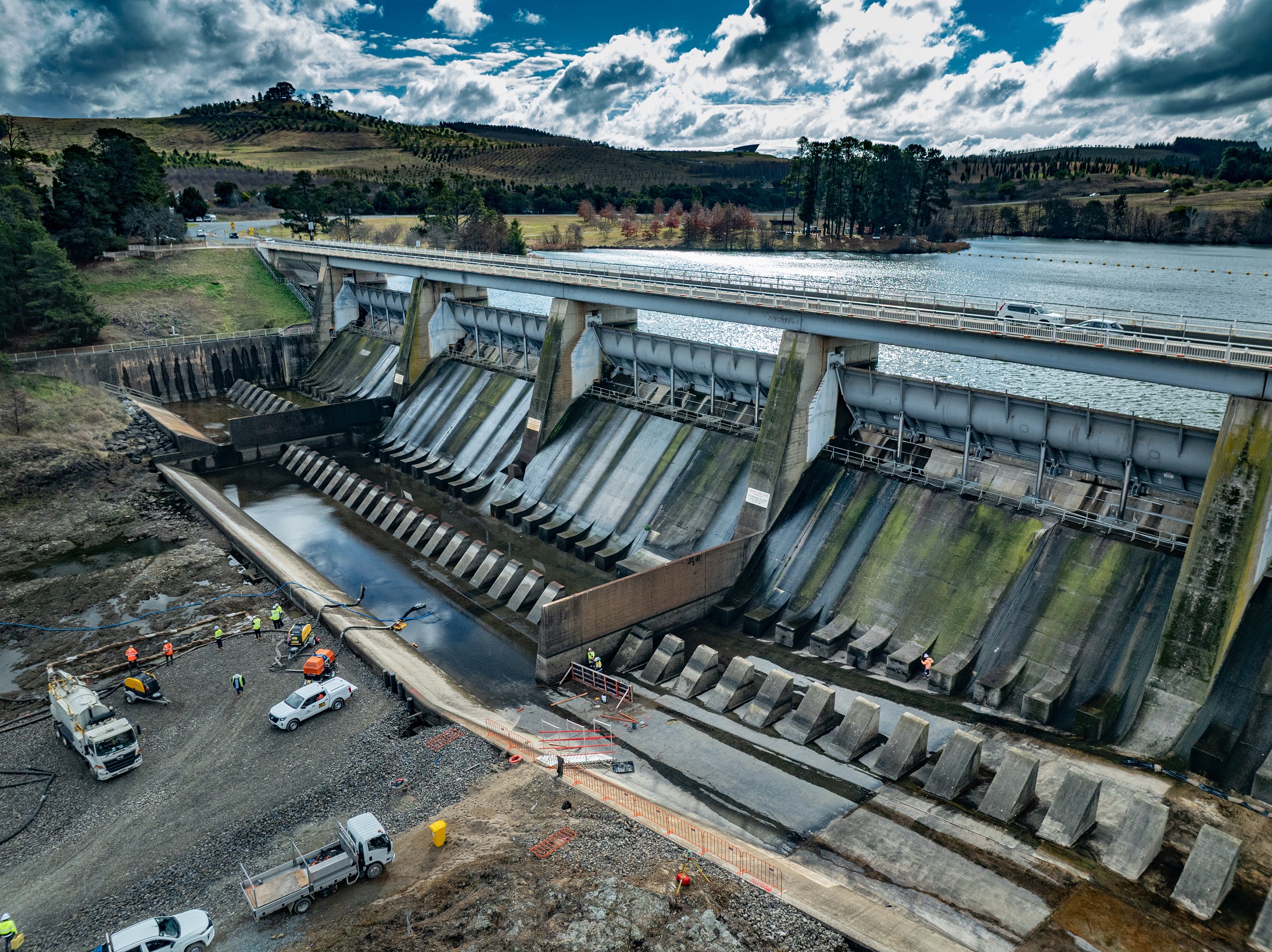

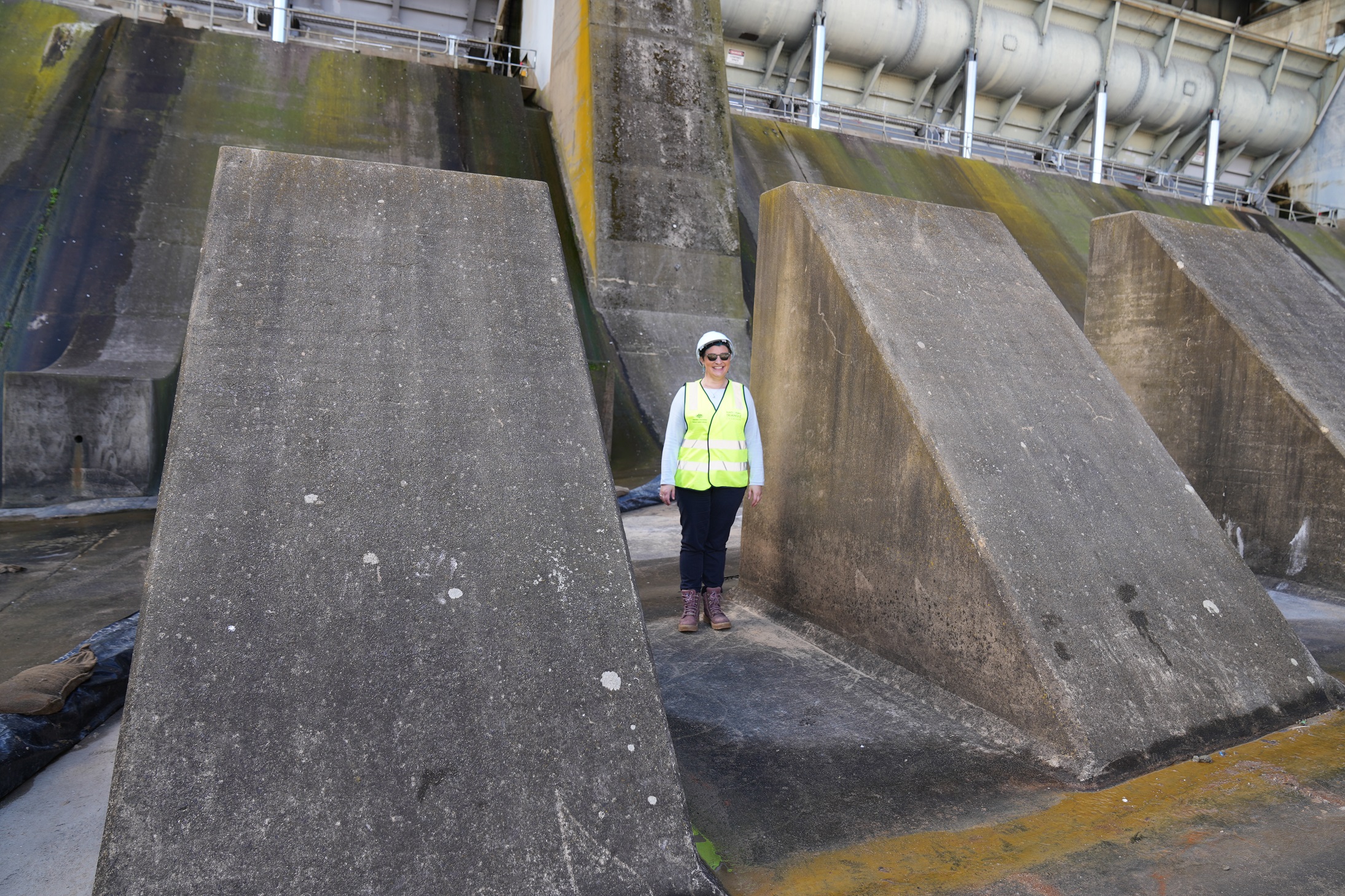

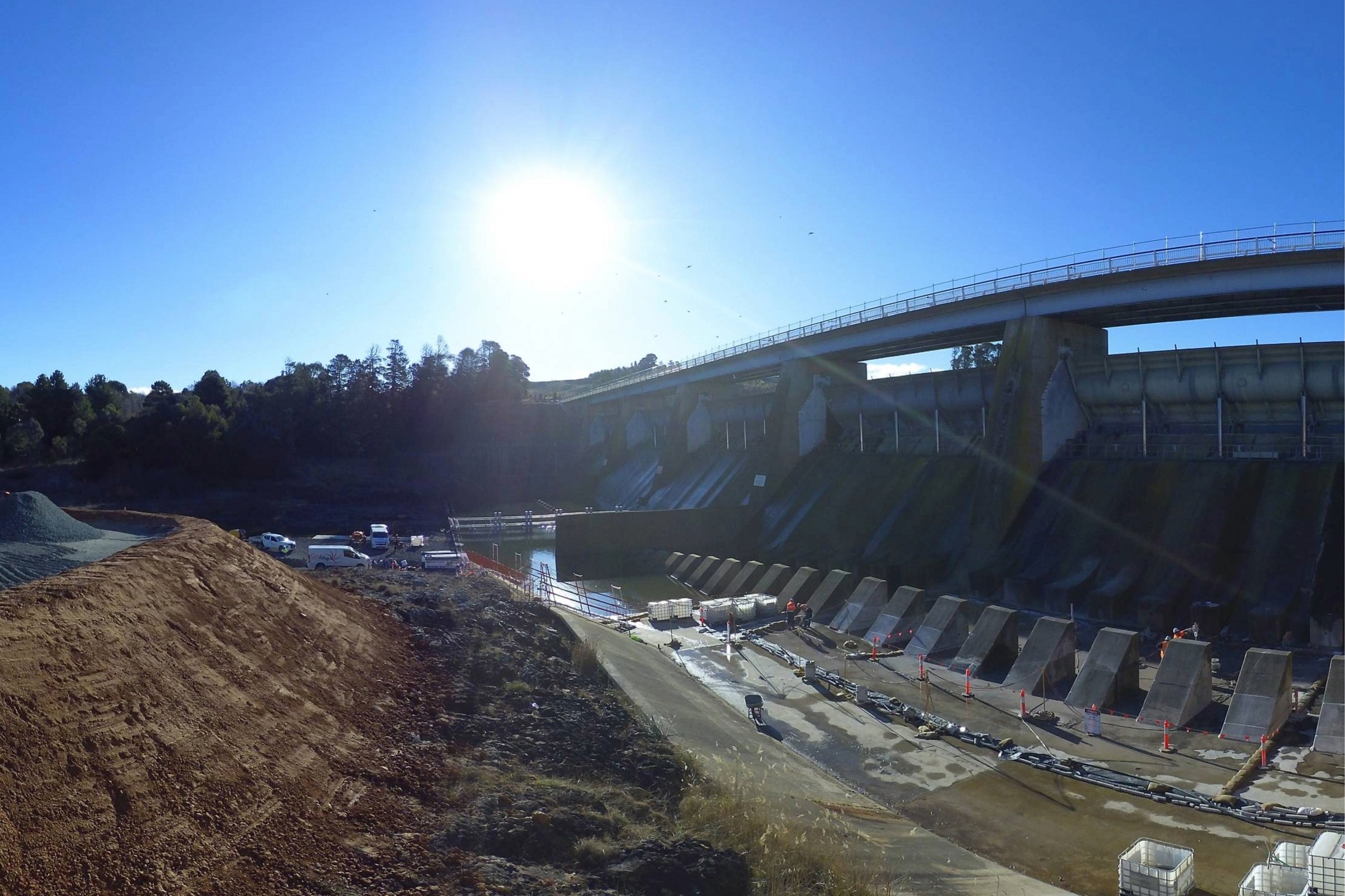

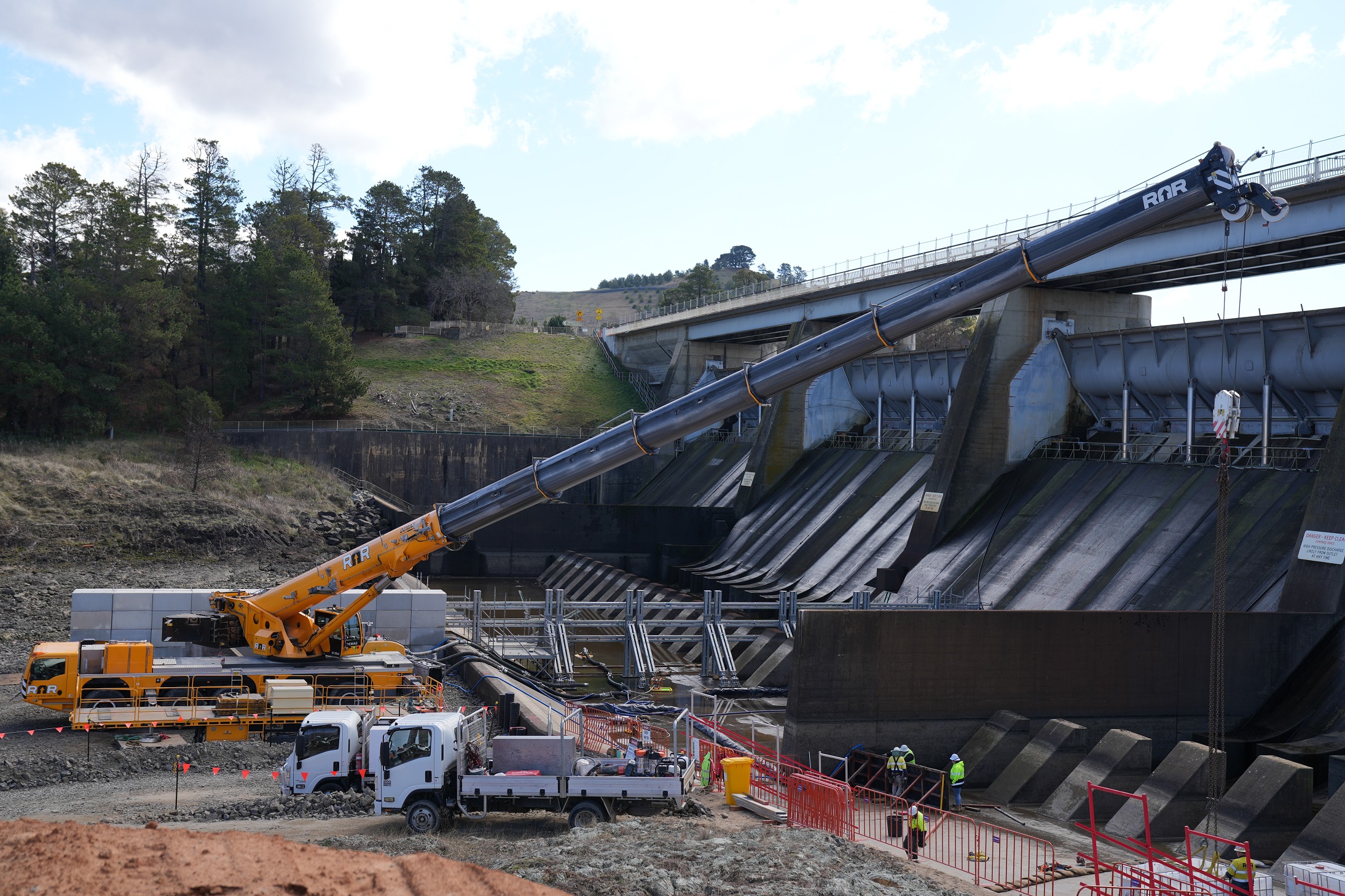

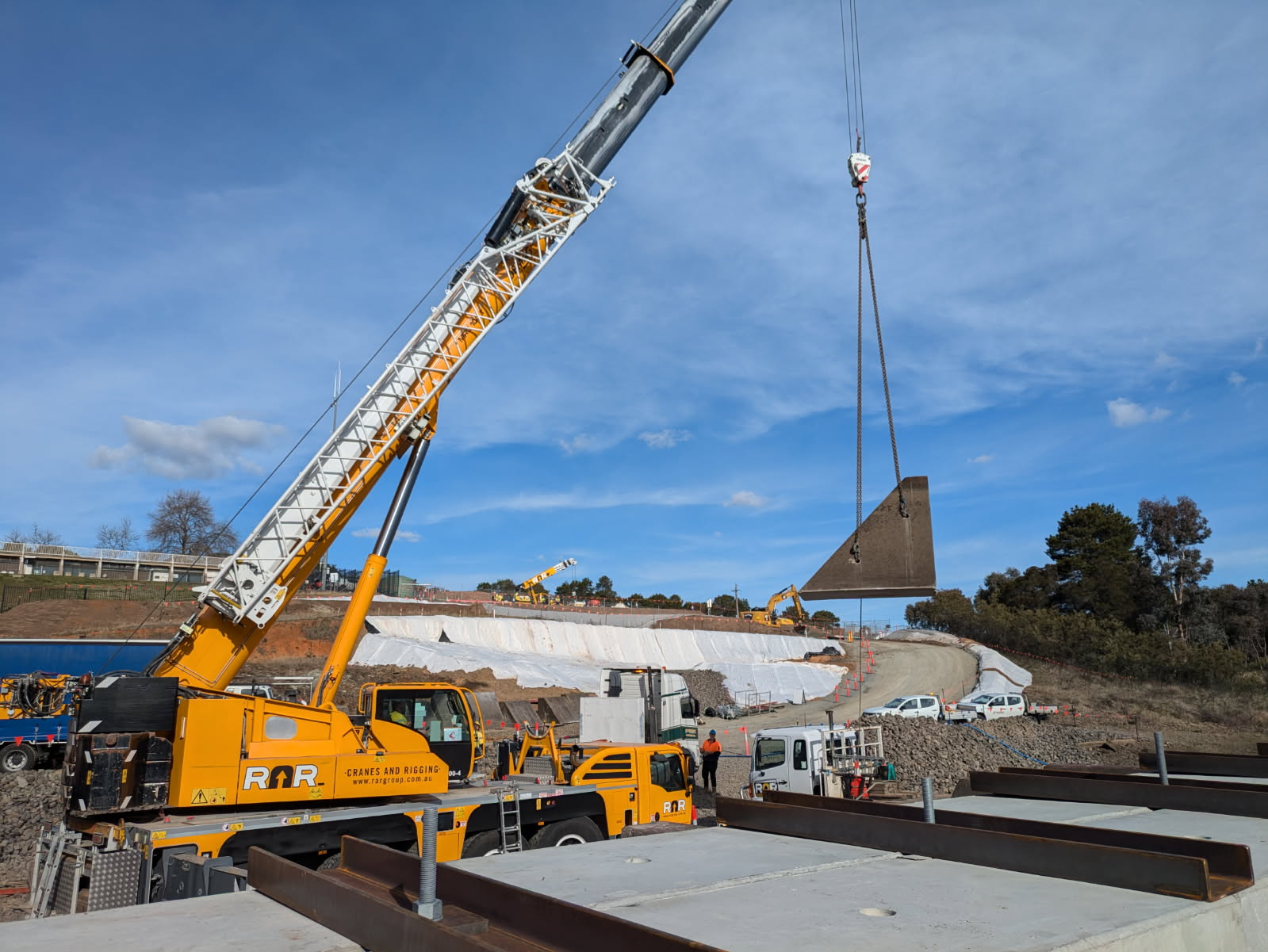

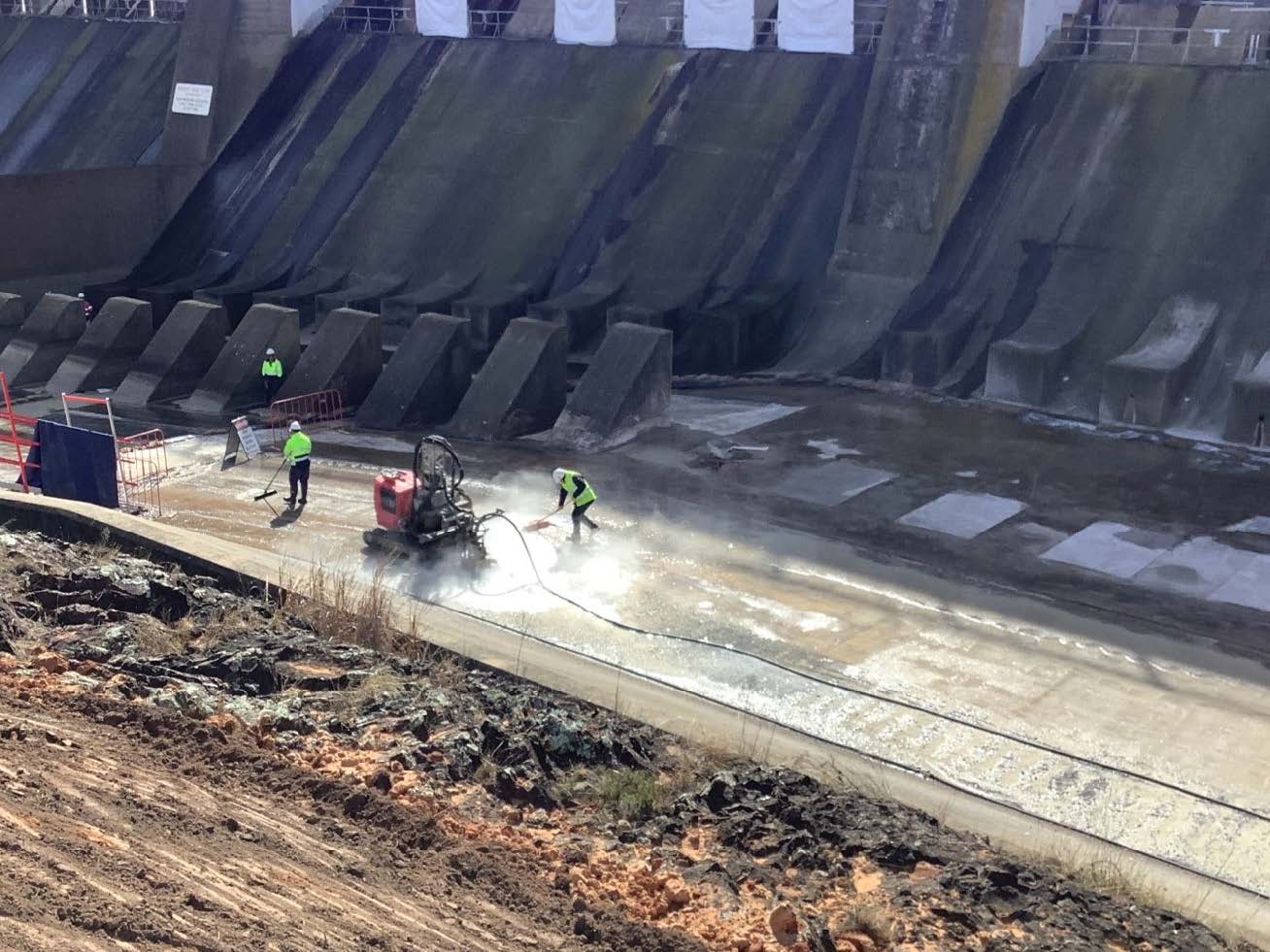

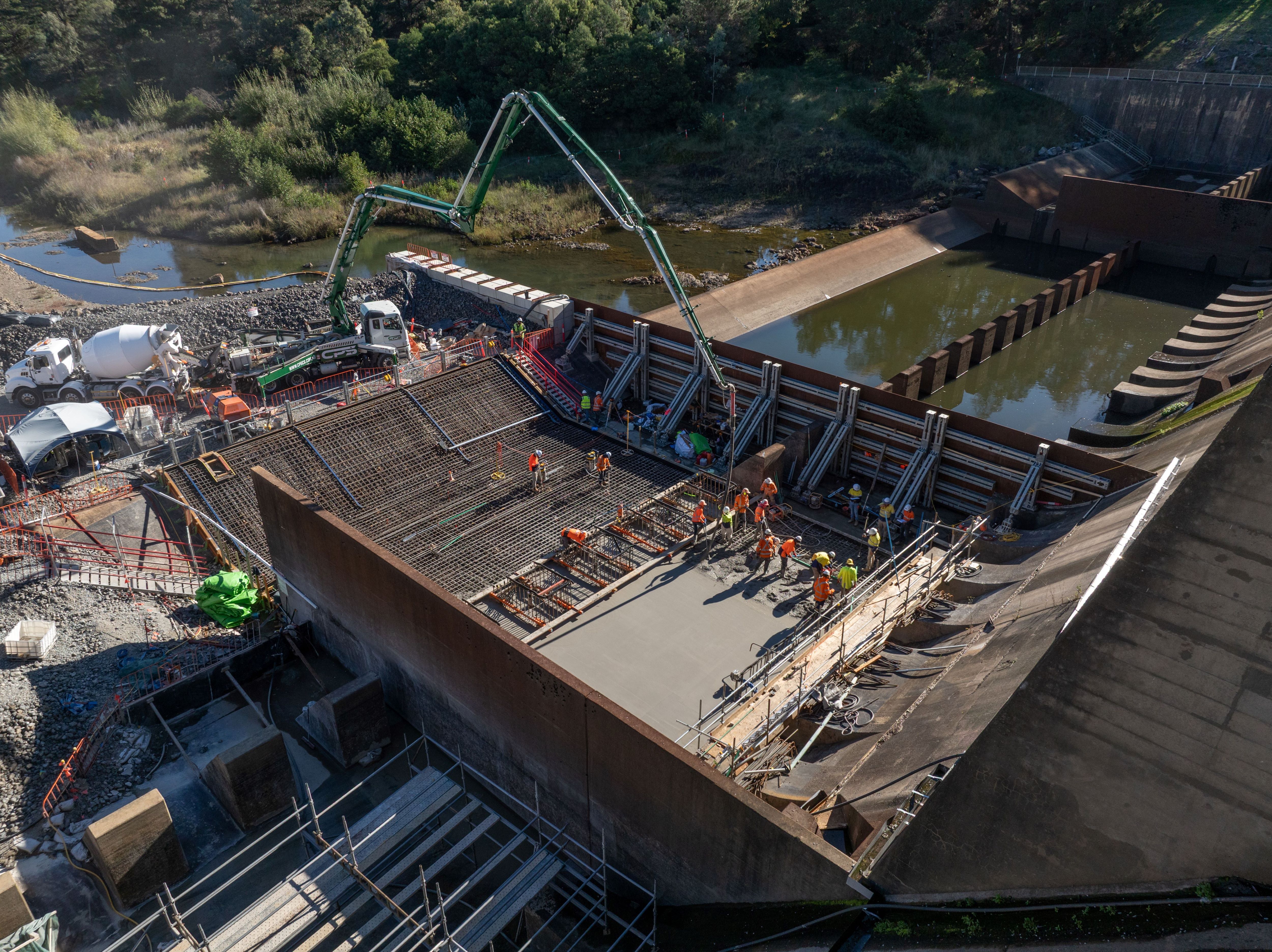

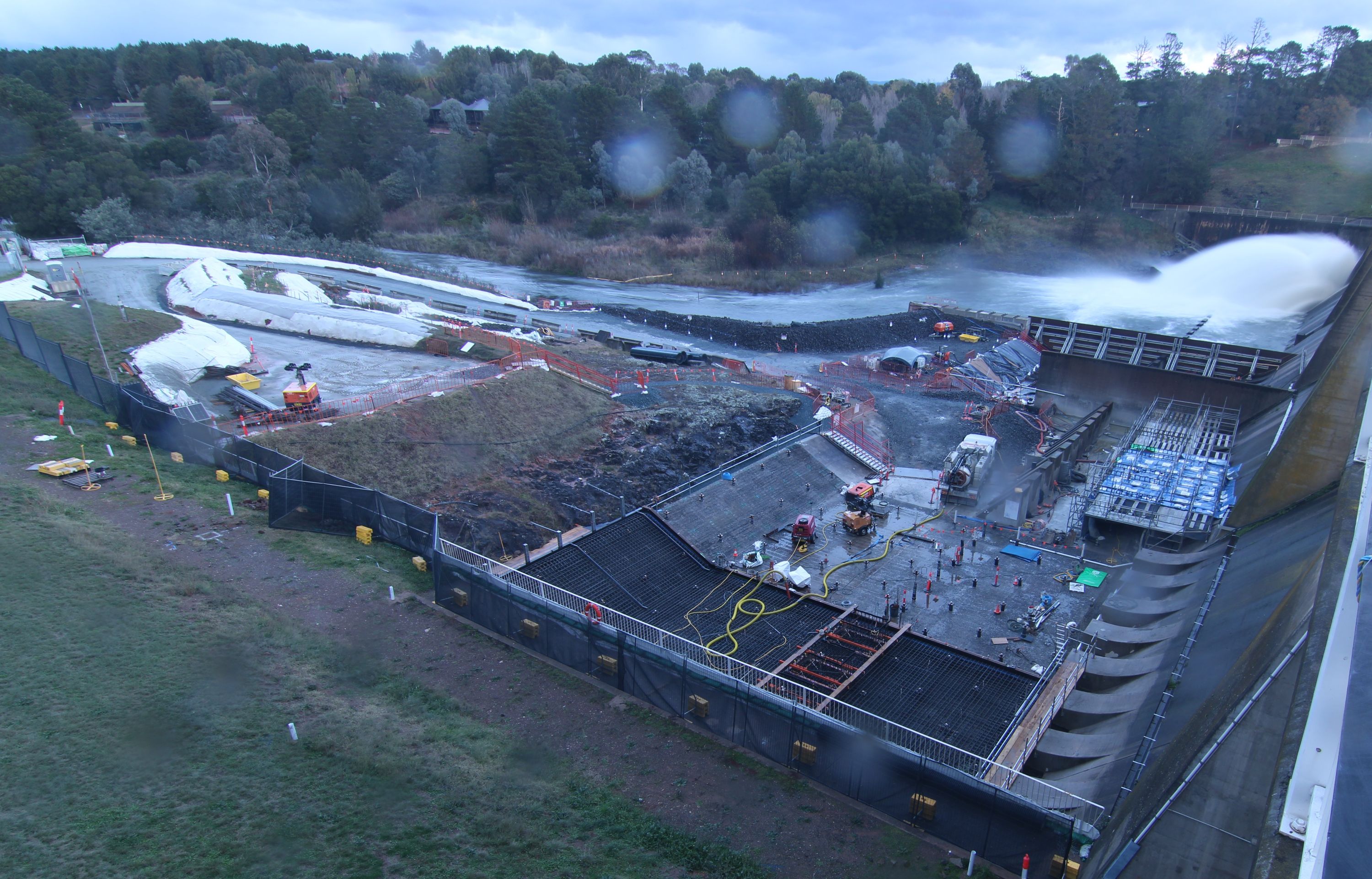

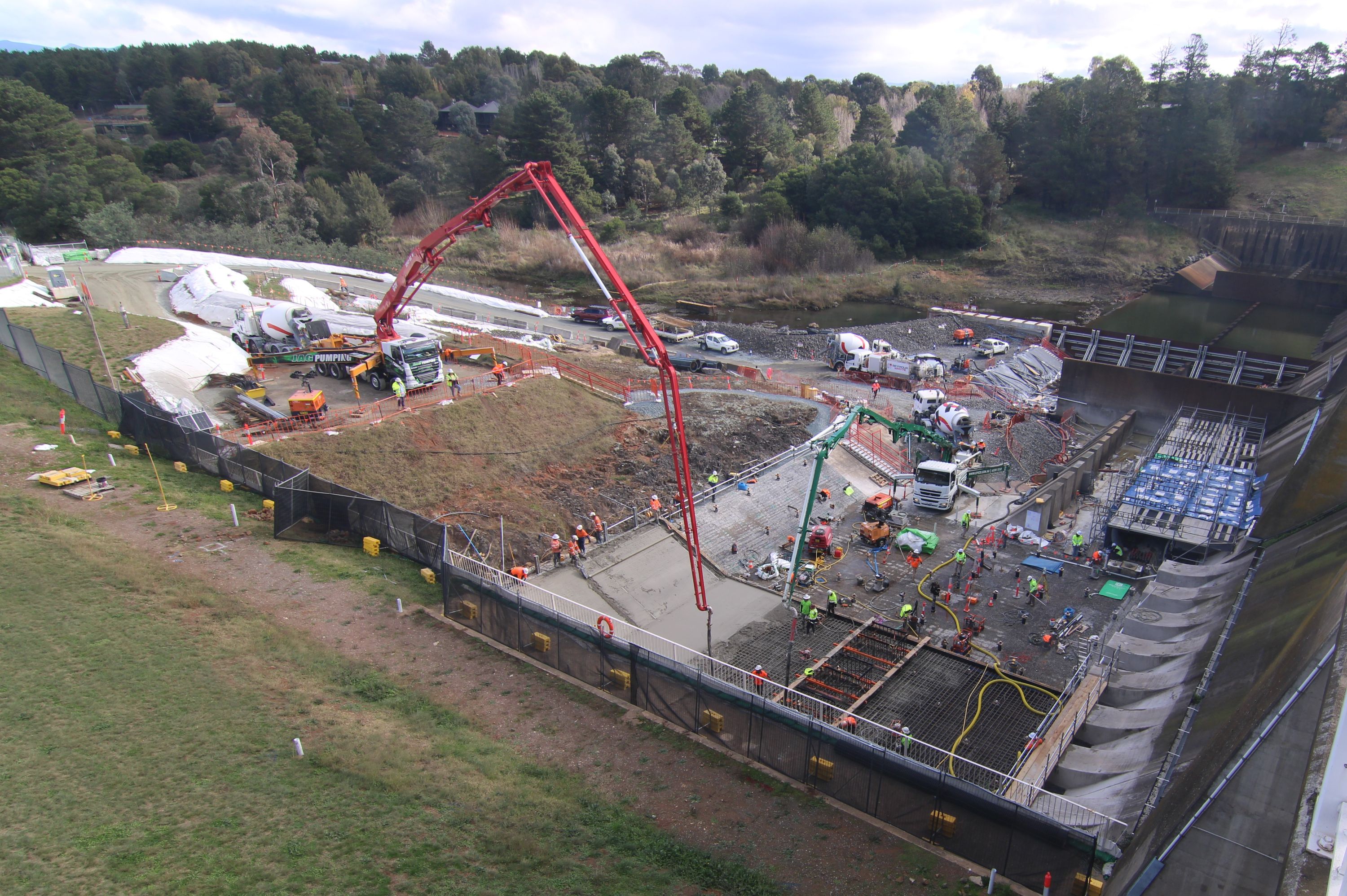

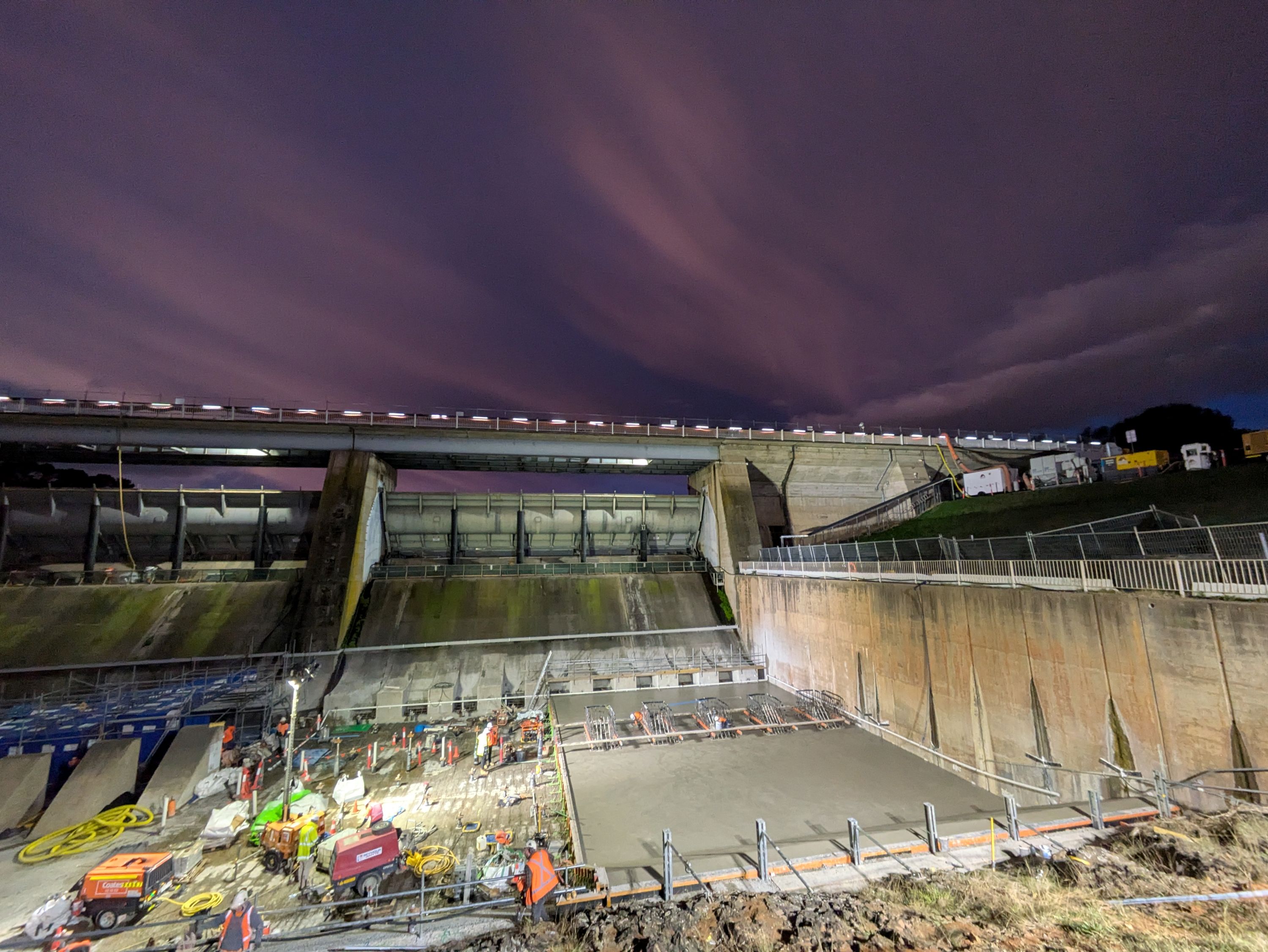

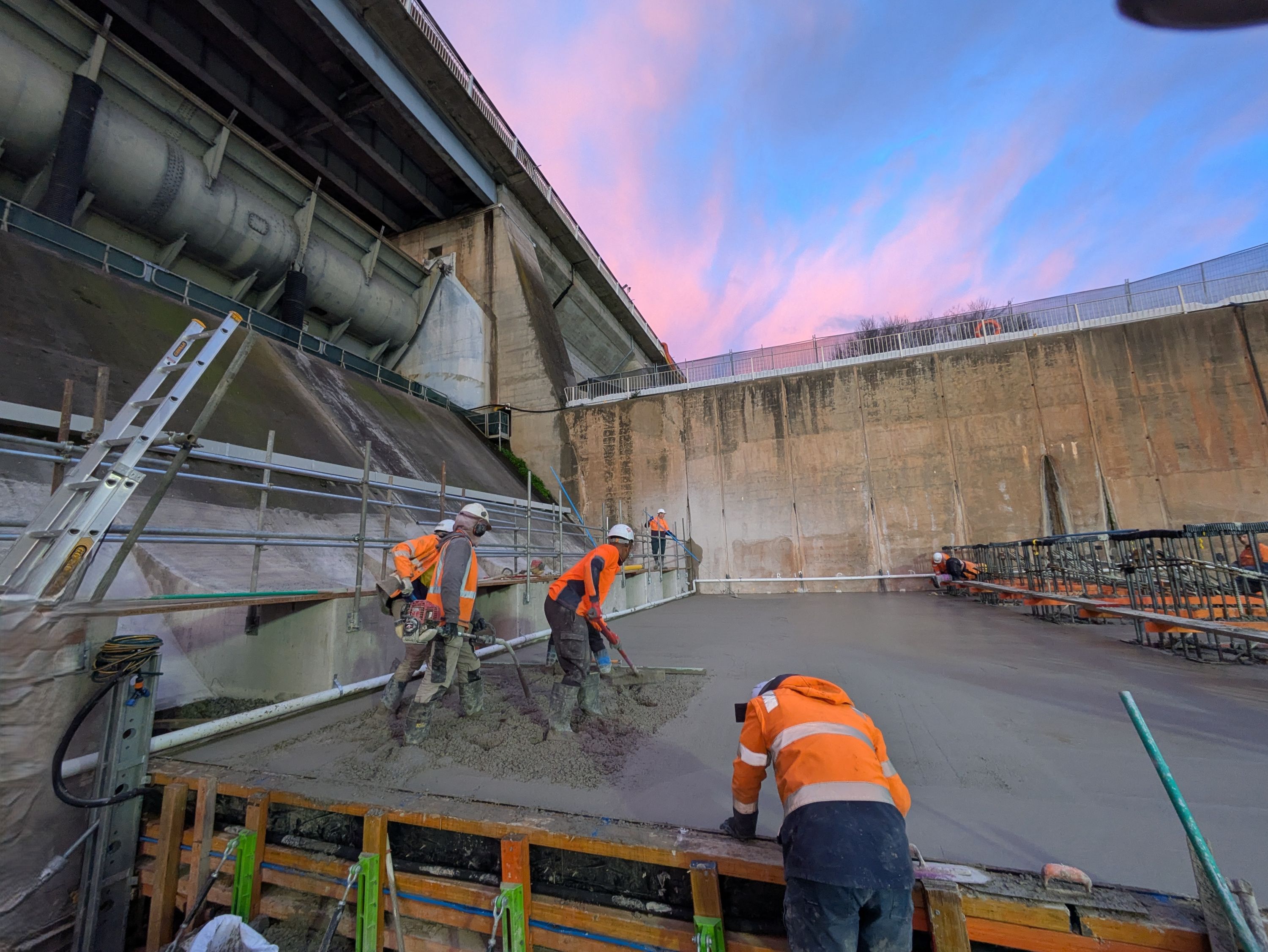

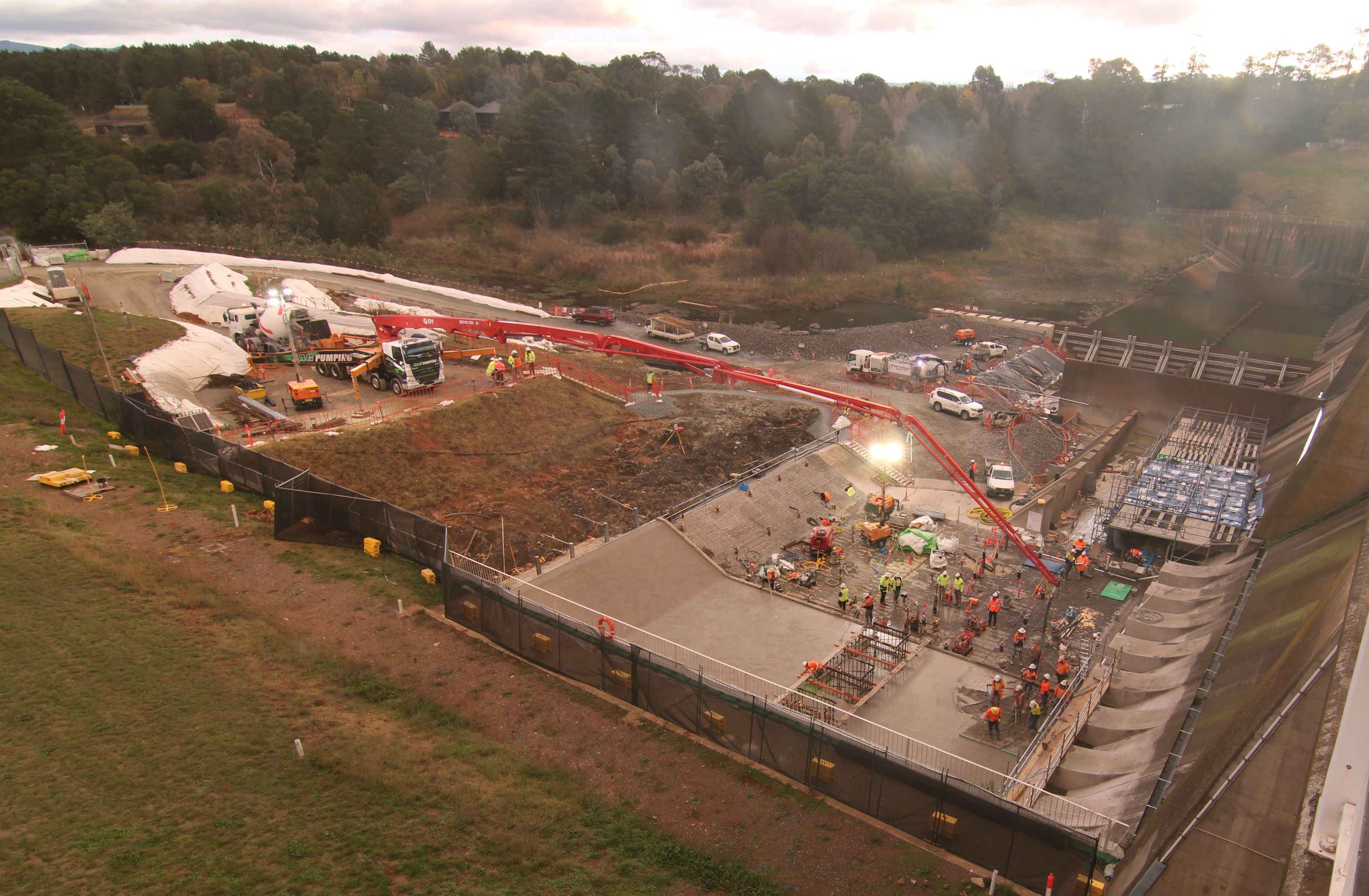

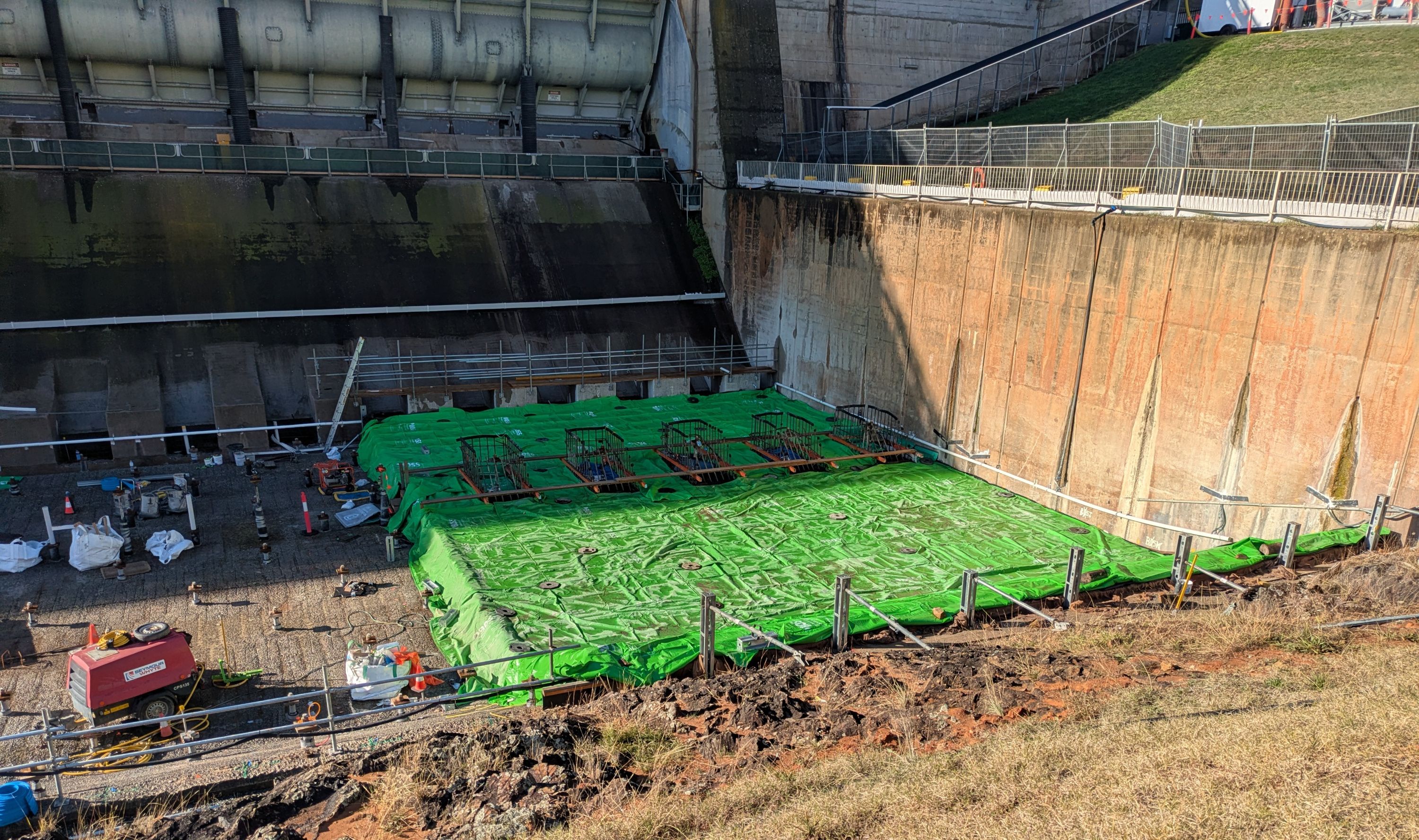

Both stages consist of demolition of the existing baffle blocks, installation of ground anchors into the foundation rock, pouring of the new reinforced concrete slab and reconstruction of the baffle blocks on top of the new slab.
Receive regular updates direct to your inbox; simply sign up using the form below
Click on the following links to view our Privacy Policy and Terms of use.
If you would like to contact the project team, email us at communications@nca.gov.au
2 December 2024: Project to Strengthen Scrivener Dam Moves Ahead
16 November 2023: Public Notification - Scrivener Dam Strengthening Project Call for EOIs
31 March 2022: Scrivener Dam to get needed upgrade
The construction of Scrivener Dam was completed in 1963 - which is now over 60 years ago. Since the dam was first constructed, the standards of construction and the body of knowledge regarding dam safety have improved.
Studies commissioned by the NCA identified the need to strengthen the Scrivener Dam Dissipator. NCA worked with the University of New South Wales Water Research Laboratory (UNSW WRL), and the Dam Safety Engineers (SMEC) to design, construct and test a scale model of Scrivener Dam. The model and other investigative methods were used to ascertain how the dam and its environs function under a range of operational scenarios.
The modelling and subsequent assessments identified structural risk with the dissipator under flood conditions. There is the potential for the dissipator to be significantly damaged during a major flood event, which in turn, could lead to the failure and subsequent collapse of Scrivener Dam. Hence, the NCA must undertake the Dissipator Strengthening project to ensure the ongoing safety of the dam.
Construction began on site in April 2025 with completion anticipated in October 2027 (weather permitting).
There will be no extended closures of the bike path or the bridge over the dam during construction. From time to time, there could be short closures to allow movement of construction vehicles, however, disruption will be kept to a minimum.

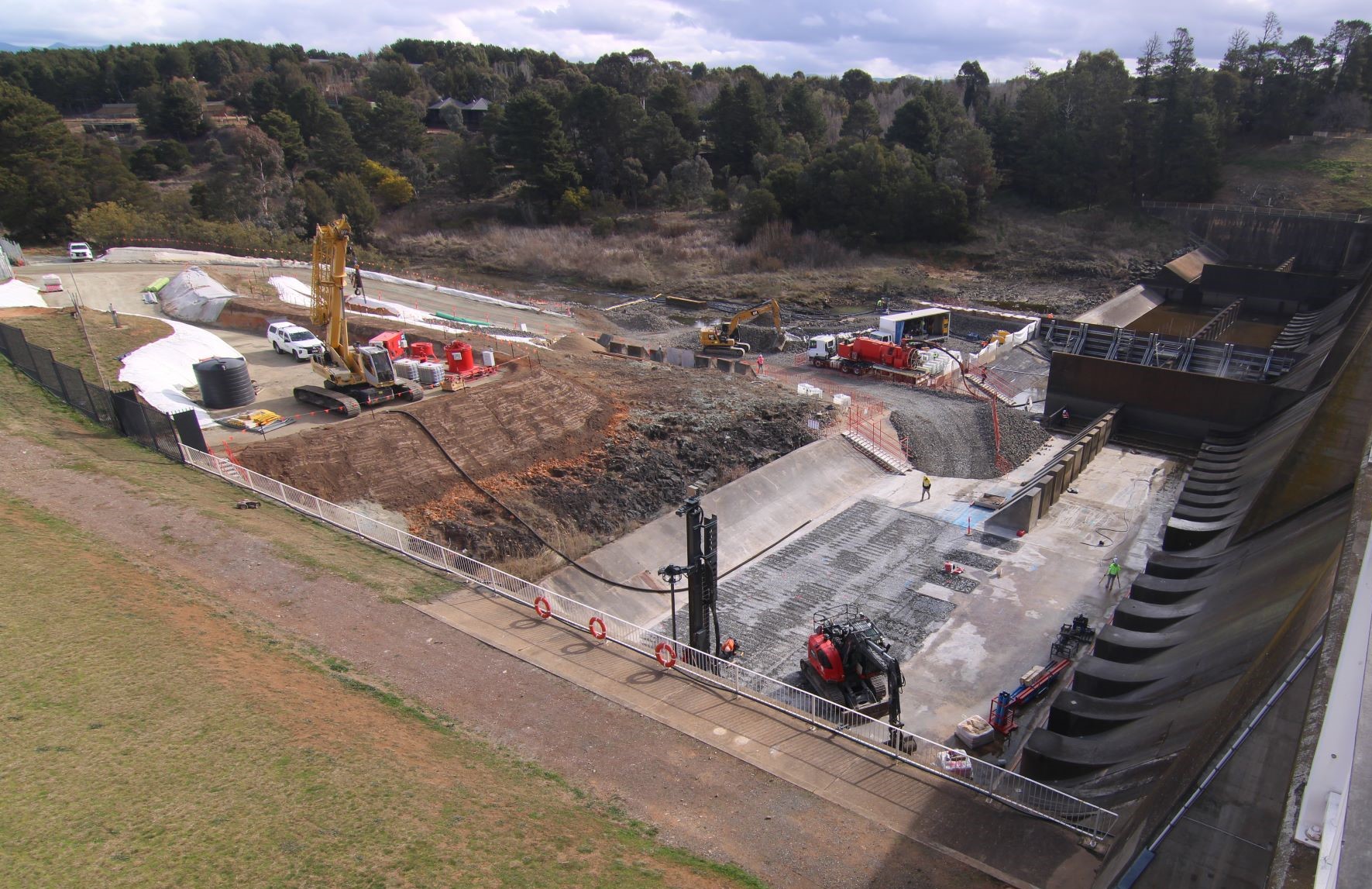

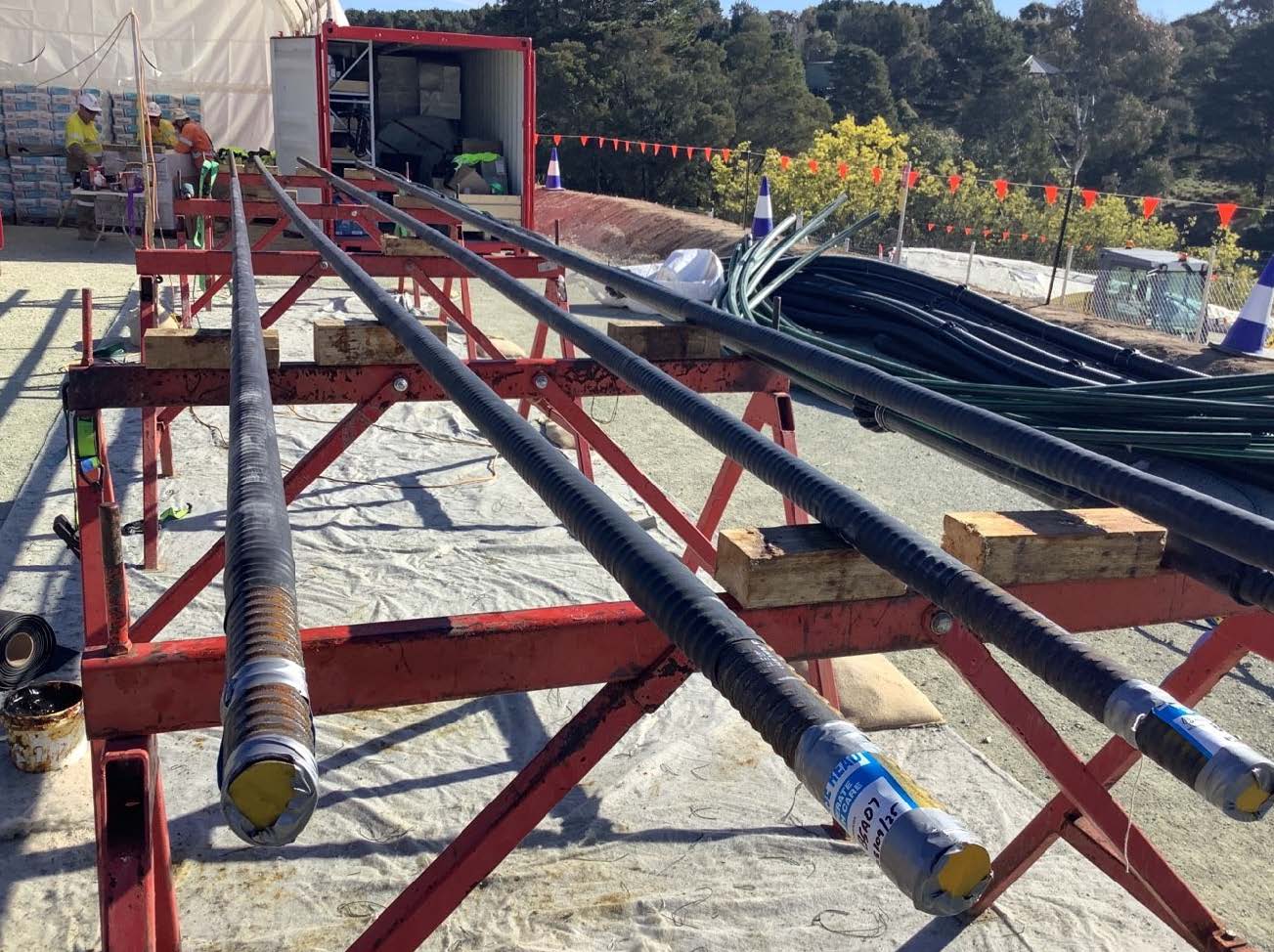

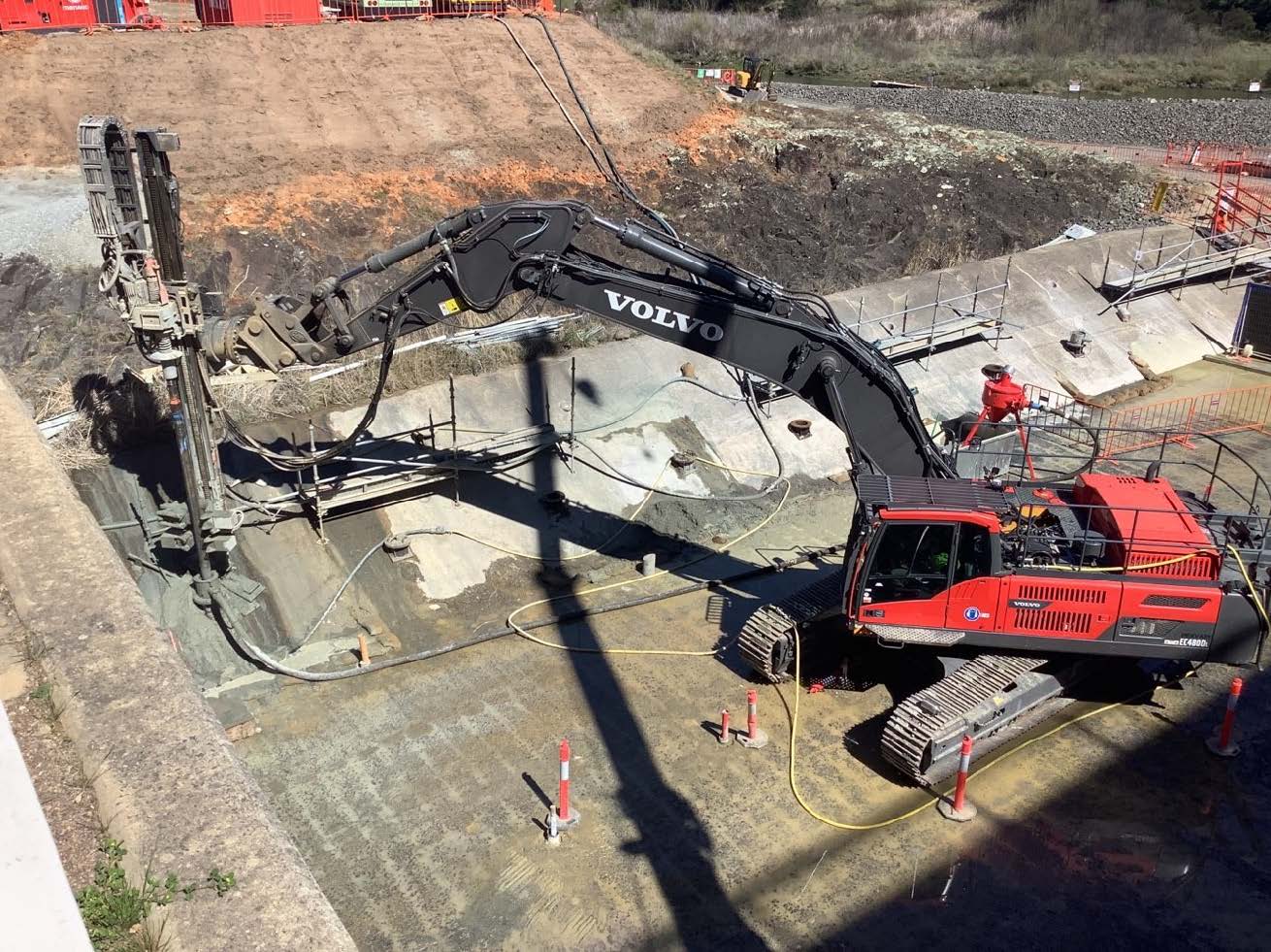

The project will involve drilling for roughly 700 new ground anchors between 10 to 20 metres deep. The process used to drill these holes will be noisy. However, the NCA undertook a noise and vibration impact assessment as part of the design for the project. The study identified all noise generated during the project will be below ACT guidelines for the areas surrounding the dam. The NCA will monitor noise during the project and will work with stakeholders to mitigate impacts during the project.
During the design phase NCA liaised with the National Zoo and Aquarium to ensure their awareness of the planned works. NCA modelled the predicted noise levels and simulated the predicted noise levels at sensitive areas of the zoo in the presence of qualified zoo staff. These tests found there would be low noise impact for sensitive areas around the zoo. Mitigations have been implemented including limiting the work hours for the project. NCA and the Head Contractor have also installed noise monitoring for the project and will continue monitoring to ensure noise levels are managed during construction.
