Project timeline
2021
- Project first announced
2022
- SMEC announced as design consultant and concept design phase commences
2023
- Funding allocated for detailed design and construction
- Community engagement on the concept design
- Parliamentary Committee on Public Works Inquiry
2023/2024
- Procurement via open tender for detailed design and construction
2025
- Seymour Whyte Constructions announced as Head Contractor
- Detailed design phase including NCA Works Approval process
- Preliminary construction works begin
2026
- Stage 1: closure of the northbound bridge side
2027
- Stage 2: closure of the southbound bridge side
- Completion of major construction works
Early 2028
- Minor works including landscaping complete
- Project completion
Project status

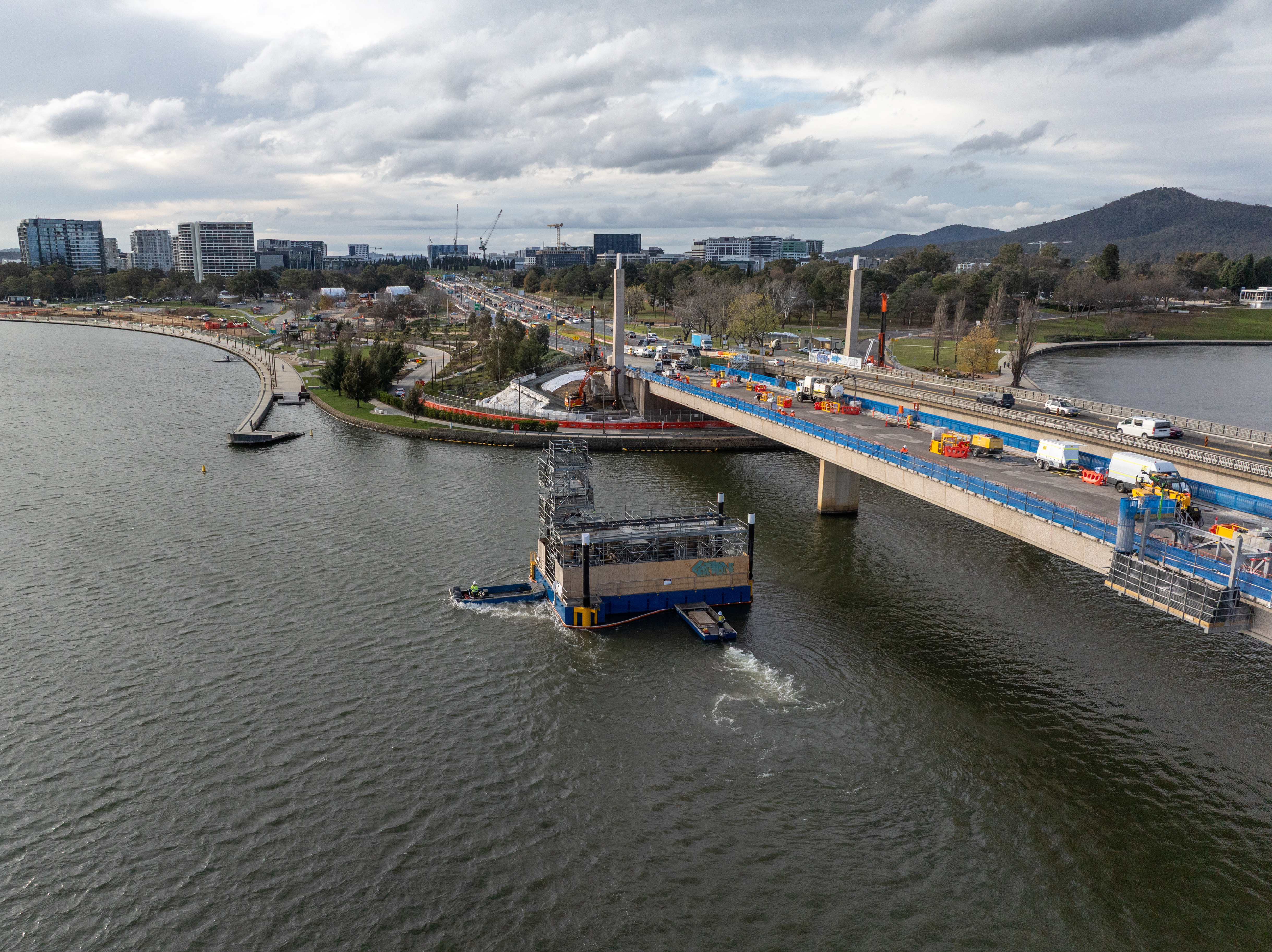

Seymour Whyte was awarded the detailed design and construct contract in March 2025. As part of the detailed design phase, investigations including survey and geotechnical works were carried out between April and September 2025.

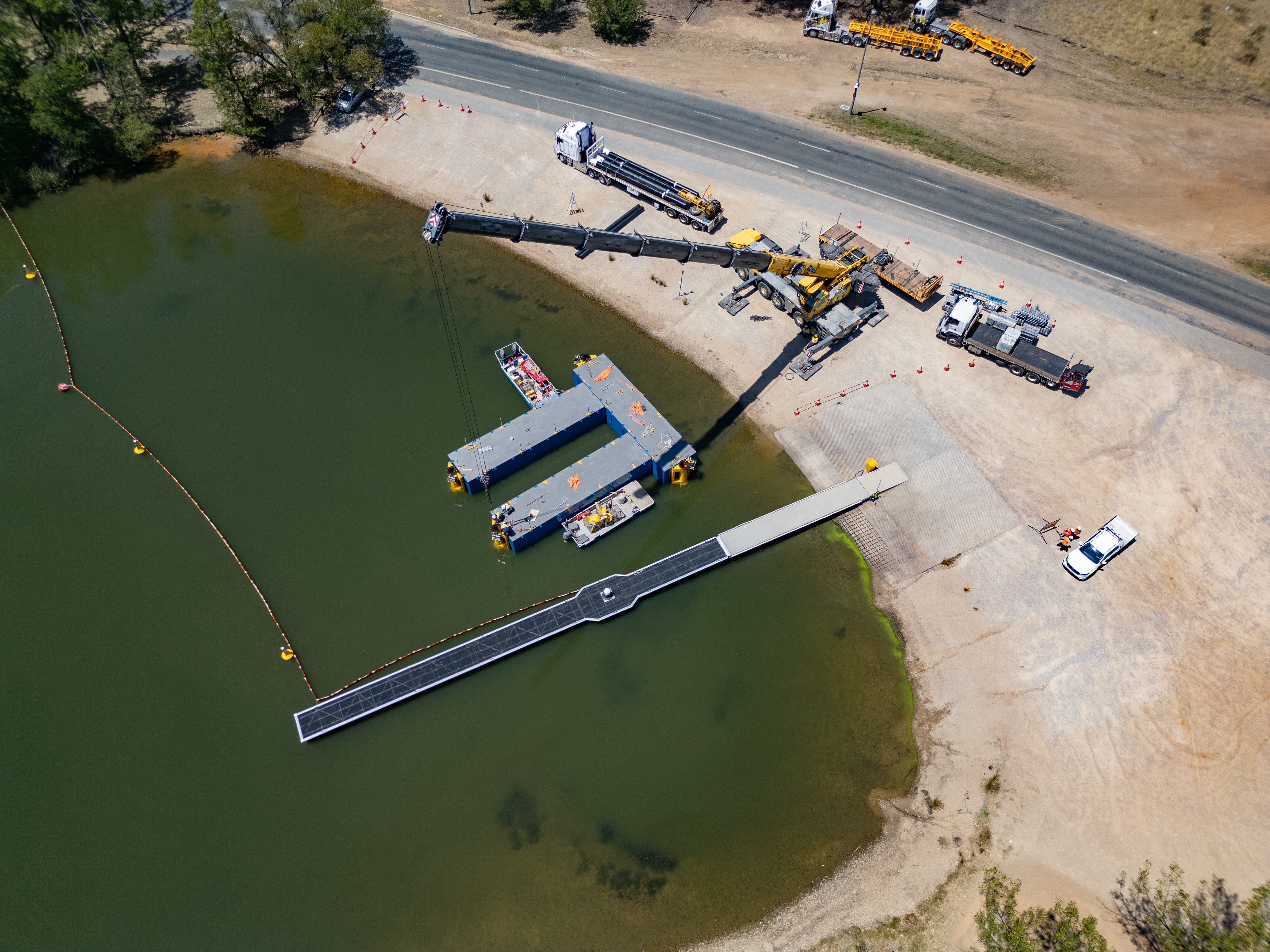

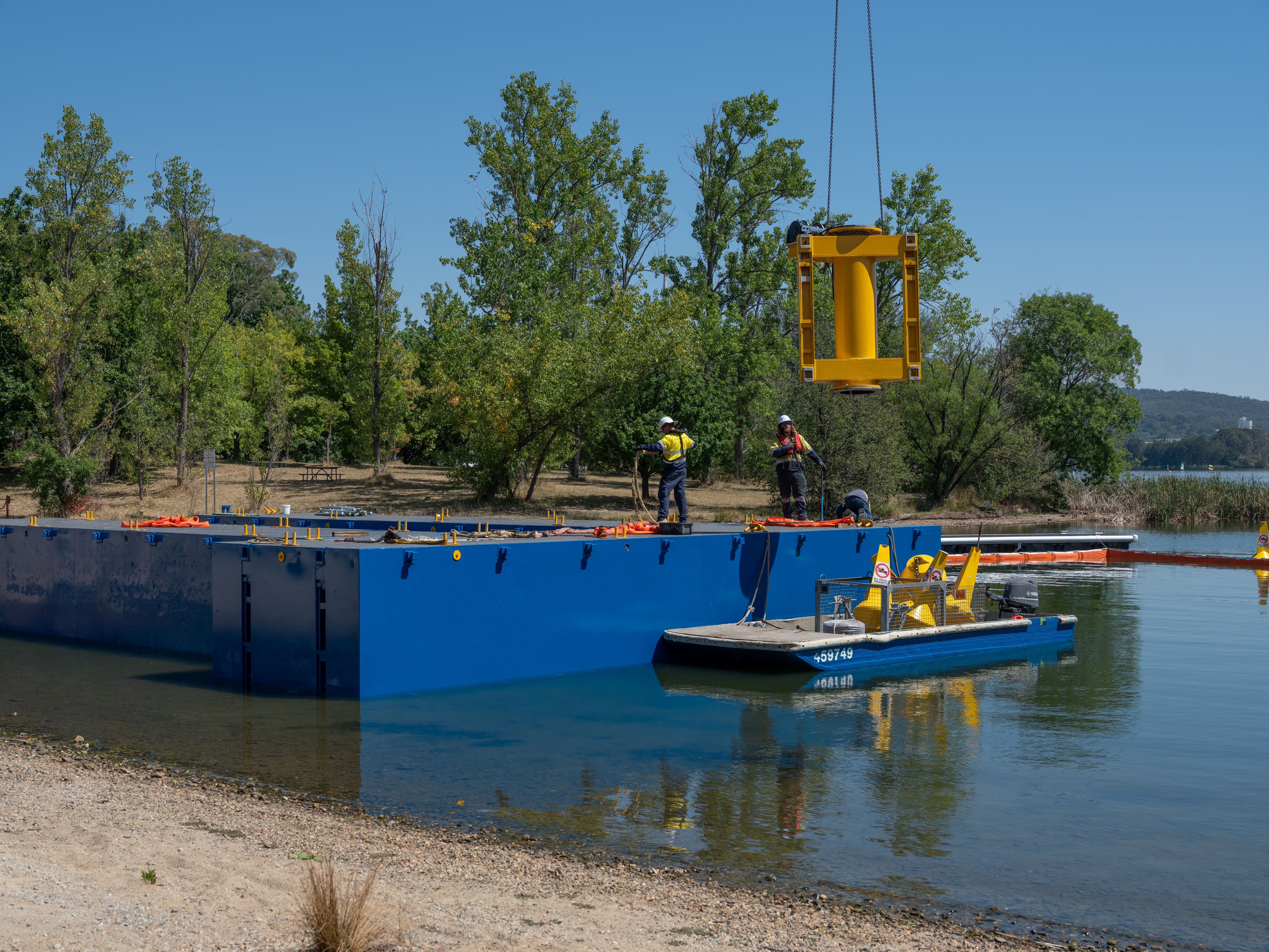

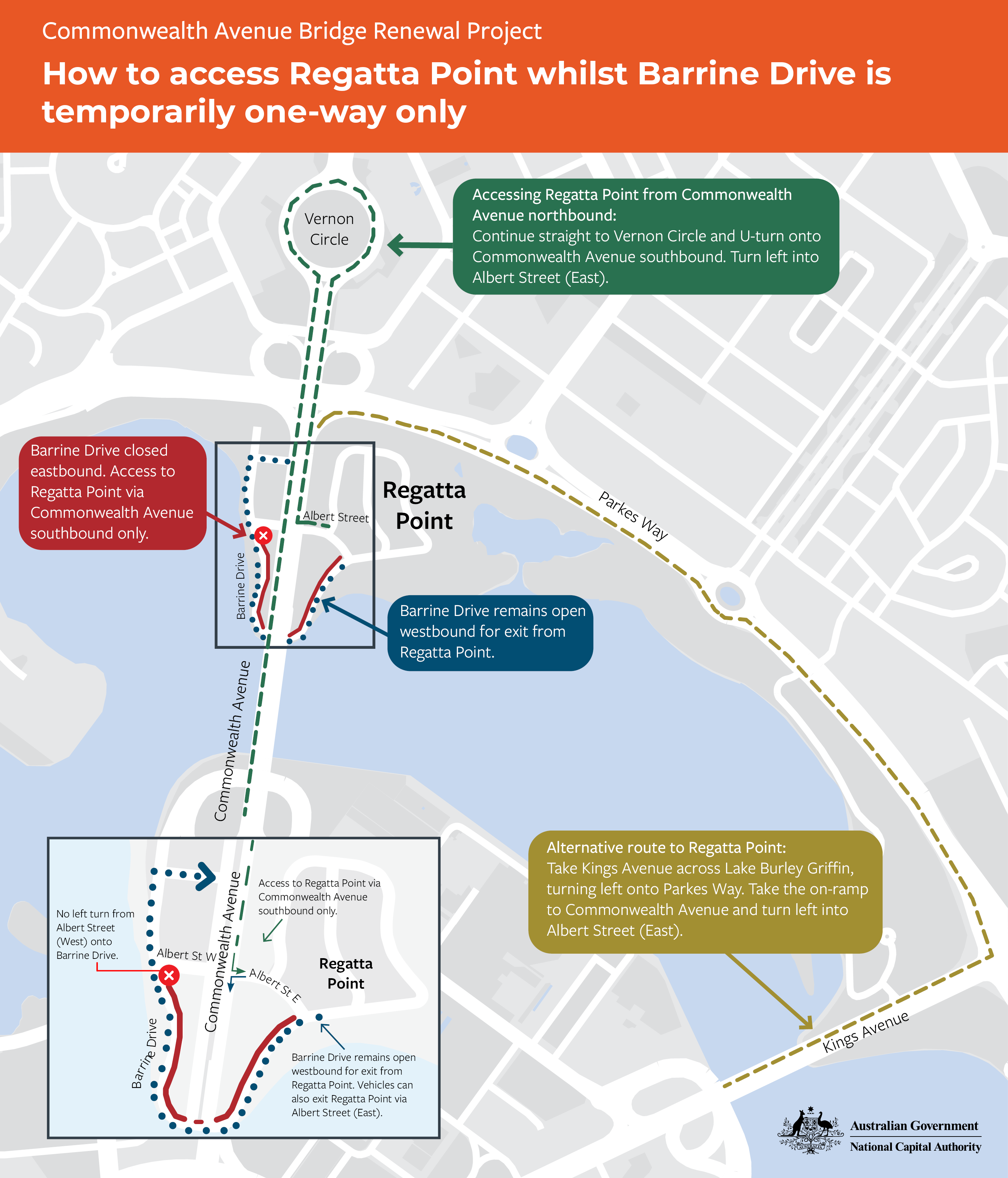

A site compound has been set up in the Barrine Drive short stay carpark. The carpark is being permanently removed as part of these works. The main site compound has been established south of Commonwealth Avenue Bridge within the Flynn Drive cloverleaf for the construction period.

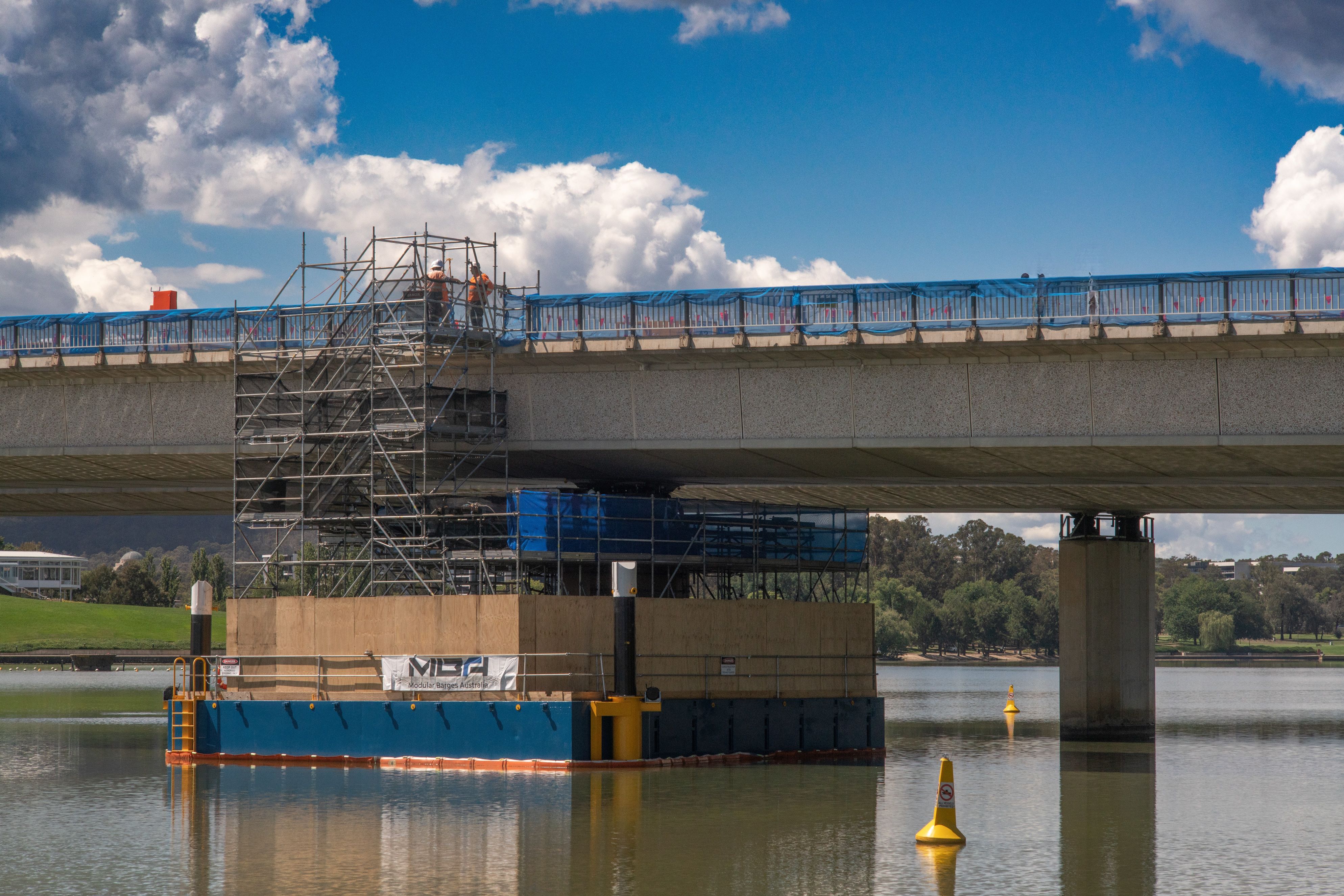

Construction will be completed in two main stages with each stage anticipated to take around 12 months.
- Stage 1: northbound bridge side
- Stage 2: southbound bridge side.
Due to the nature of the works being undertaken to strengthen the bridge, it is necessary to close each side of the bridge one at a time to enable the upgrades. This includes the traffic lanes and the shared path. One side of the bridge will remain open to accommodate traffic and shared path users. There will be one lane of general vehicle traffic in both directions. The second northbound lane will be a bus and emergency services priority lane.

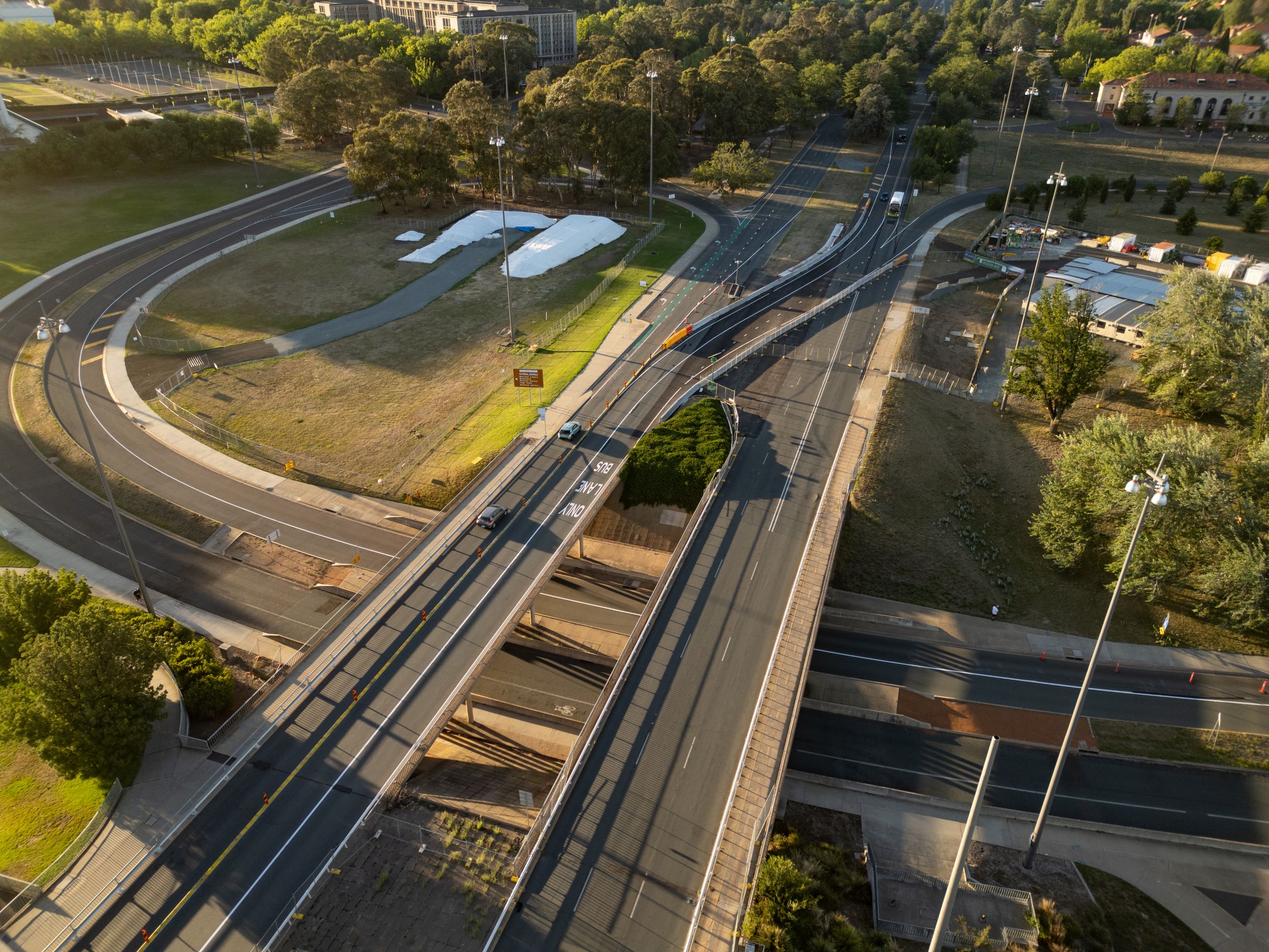

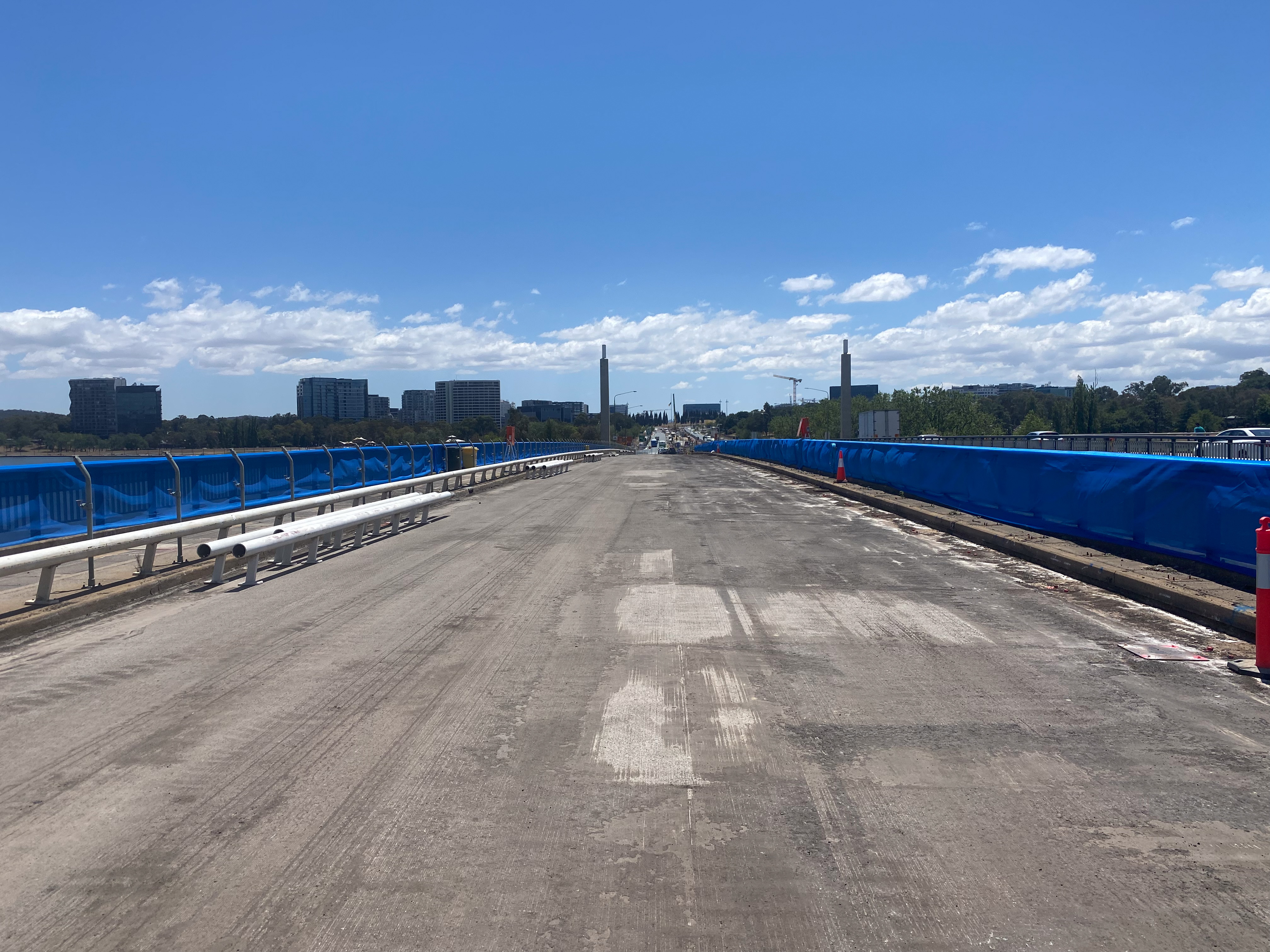

Construction
To ensure all activities are completed as safely and efficiently as possible, hours of work during the construction phase will be:
- Weekdays (Monday to Friday): 7am to 6pm
- Saturday: 8am to 1pm (as required).
Any activities requiring completion outside of these hours will be notified to the community ahead of time.

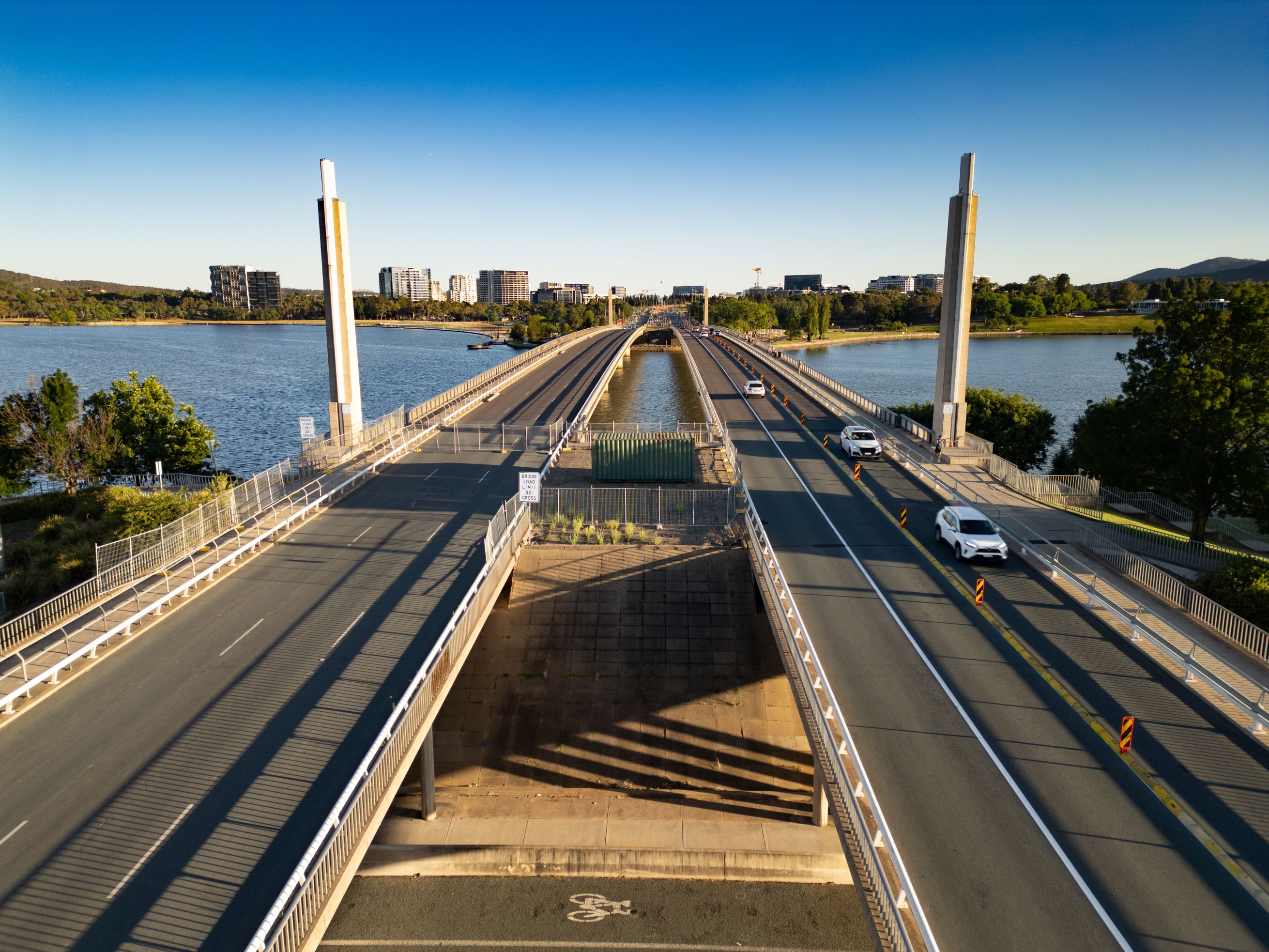

Traffic management during main bridge construction
There will be significant changes and traffic impacts, including for shared path users.

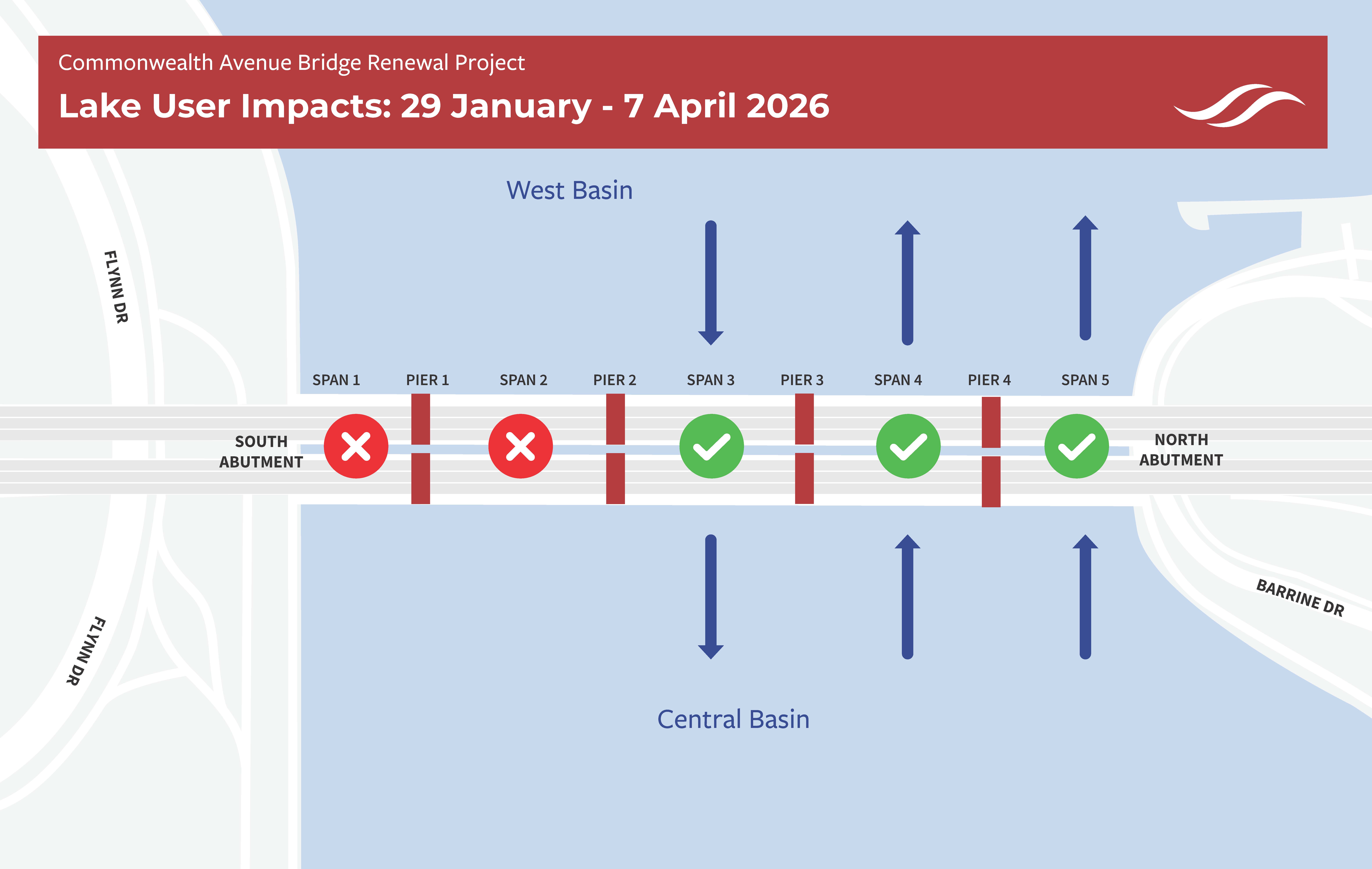

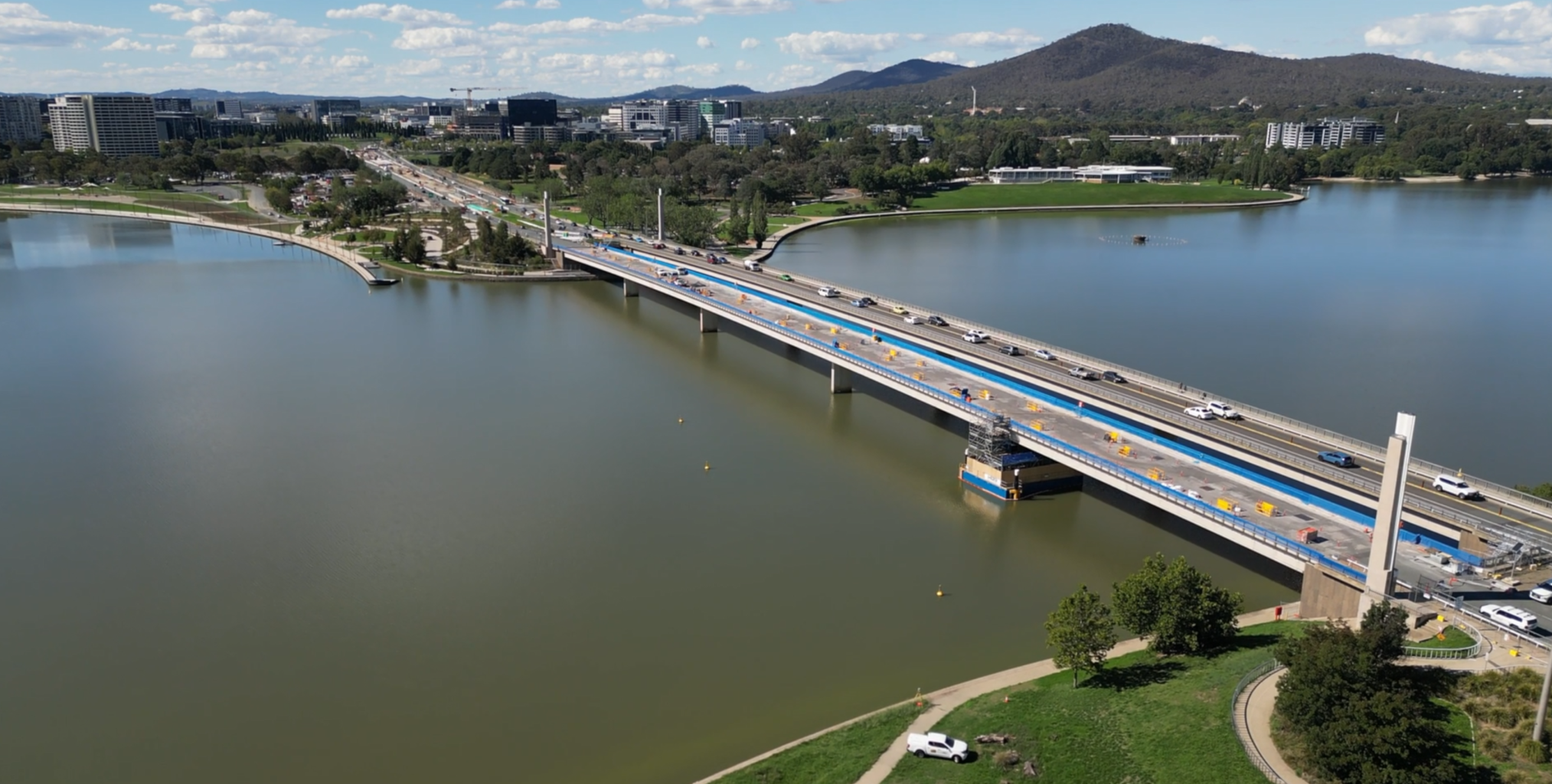

Each side of Commonwealth Avenue Bridge will be closed for up to 12 months each (weather permitting). This includes the traffic lanes and the shared path. One side of the bridge will remain open.
We have been working closely with the ACT Government on traffic arrangements for the construction period. During construction there will be two northbound lanes and one southbound lane available on the open bridge side. There will be one lane of general traffic in both directions. The second northbound lane will be a bus and emergency services priority lane.
Canberrans and visitors to the National Capital can expect the following changes from Thursday 8 January 2025 and for the duration of Stage 1 (approximately 12 months, weather permitting):
- full closure of the northbound side - lanes and shared path – of Commonwealth Avenue Bridge
- the open side of the bridge will have; two northbound lanes with one for general traffic and one bus and emergency services priority lane and one southbound lane for general traffic
- closure of the Flynn Drive on-ramp to Commonwealth Avenue northbound for general traffic; road users will be detoured via Coronation Drive
- general traffic travelling northbound (towards the city) will merge into one lane near Albert Hall and move onto the southbound side of the bridge via the newly constructed crossover lanes
- general traffic travelling southbound (toward Parliament House) will merge into one lane after Albert Street and continue on the southbound side of the bridge
- full closure of the shared path on the northbound span of Commonwealth Avenue Bridge with shared path users detoured onto the southbound side via:
- Flynn Drive or Barrine Drive, beneath Commonwealth Avenue Bridge
- the pedestrian underpass near Albert Hall/the Hyatt Canberra
- the pedestrian traffic lights near Albert Street.
Note: at times there will be no stair access for shared path users along the southbound side of the bridge. The ramps at both ends will remain open.
There will be significant disruptions to the road network during construction and road users are encouraged to allow extra travel time and consider what choices you can make to improve your commute. If possible, travel outside peak times, allow extra time for your trip or find other ways to travel.
There will be changes for public transport users. Updated timetables and school packs can be viewed and downloaded on Transport Canberra's website here: Transport.act.gov.au/updated-timetable
The road network will be monitored and we will work closely with the ACT Government to regularly communicate about impacts and alternate routes. We are committed to completing works as efficiently and safely as possible.
Suggested routes for shared path users
Detour map for road users
Download a PDF copy of the map here.
